The Touchstone Campus

Growth towards independence

What is it?

The campus is an “all-in-one” operations center, providing each of 4PA’s services.

It currently includes a shop for our cleaning operation, our office, plus three newly constructed transitional shelters. As the development continues, the 1/2-acre green space will accommodate a total of eleven shelters.

Once complete, residents will have 24/7 access to common facilities, including bathrooms with showers, laundry and a kitchen. In addition, a retail/manufacturing business will be added to provide training and work for those staying at the campus.

The end result will be a safe place to learn life skills, helping individuals transition to self-sustainability in our community.

Phase 1 :

  • Occupy shop

  • Clean & secure property

Estimated completion date: ongoing

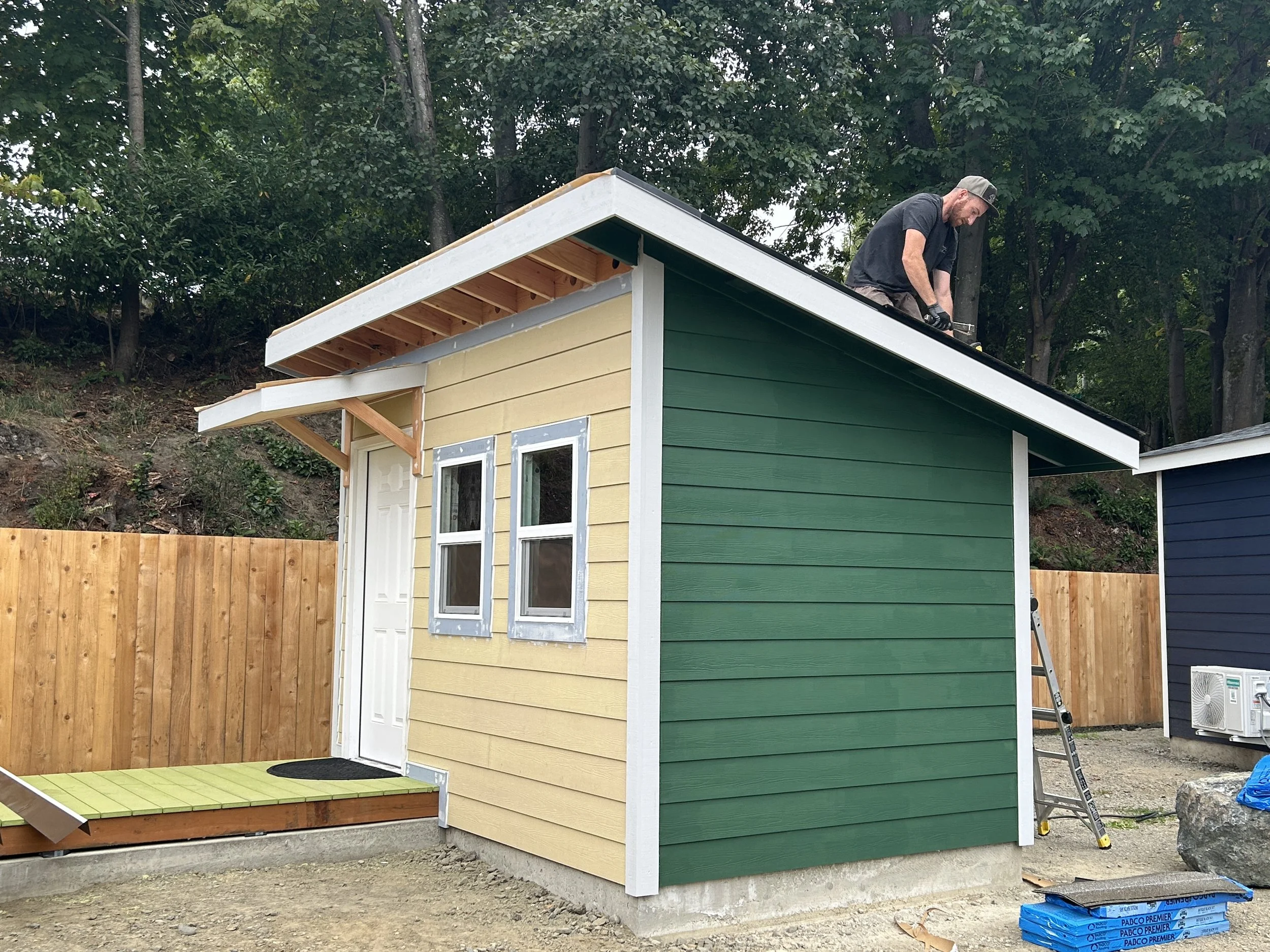

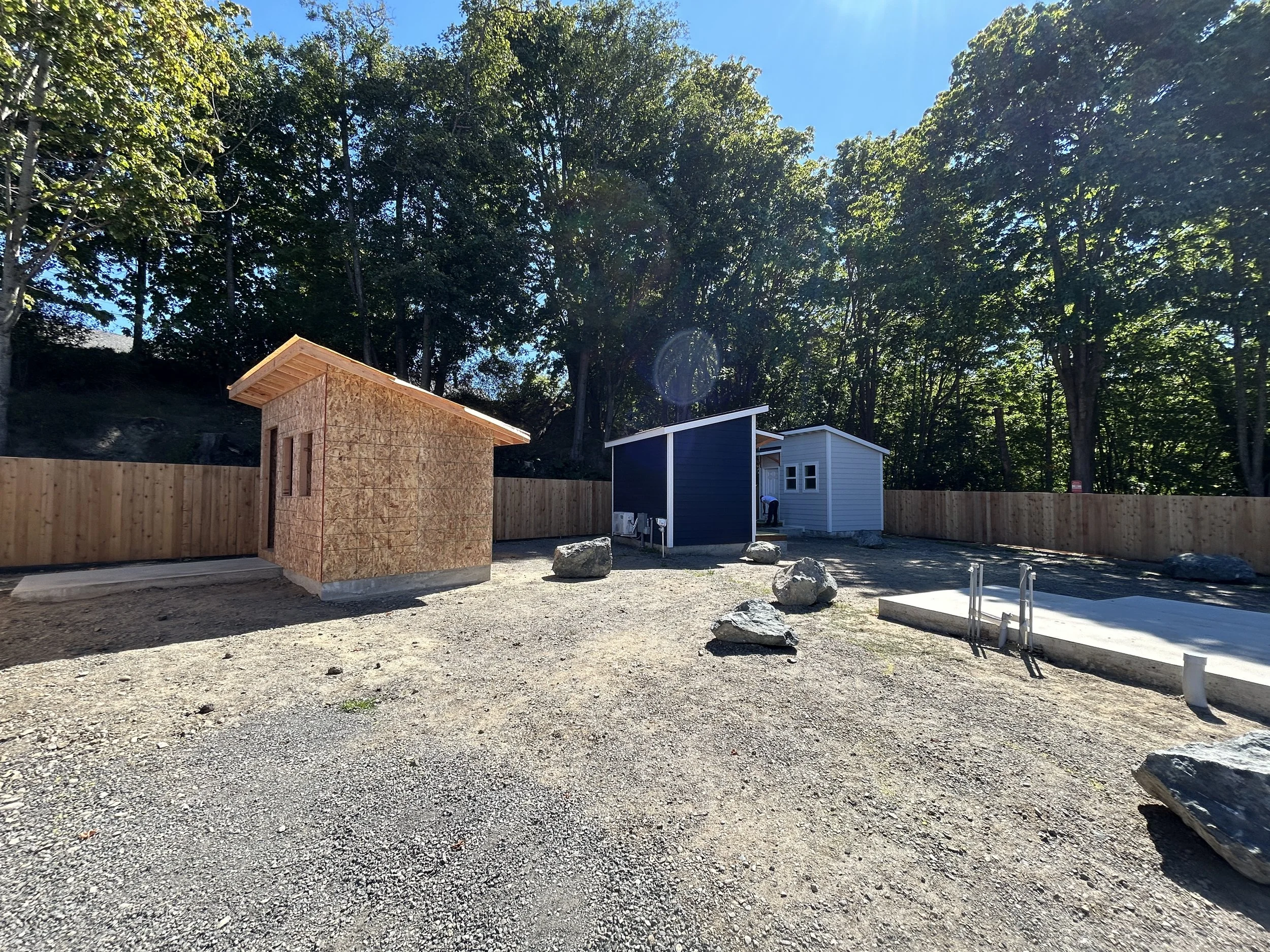

We now occupy the shop for our cleaning operation and volunteers. New equipment was both donated and purchased to help maintain the property and address any necessary repairs to the facility.

As development of Phase 2 & 3 progress we will continue to make improvements to our work space and pursue additional ways to utilize our parking lot, including designated food truck areas.

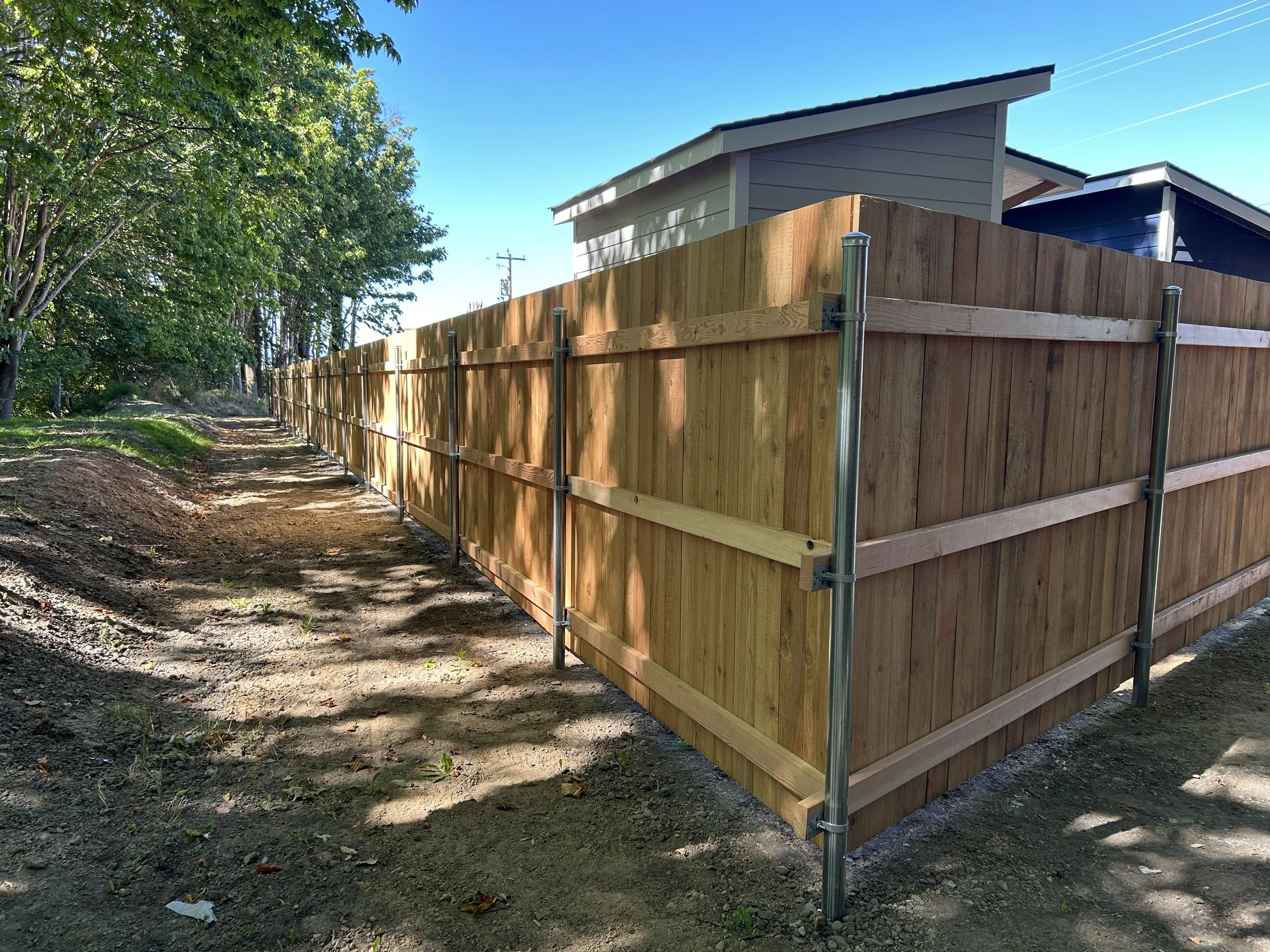

A perimeter fence was installed to control foot traffic, increase safety, and create a clear barrier between the Touchstone Campus and the adjacent Storm King Athletic Club.

Phase 2 :

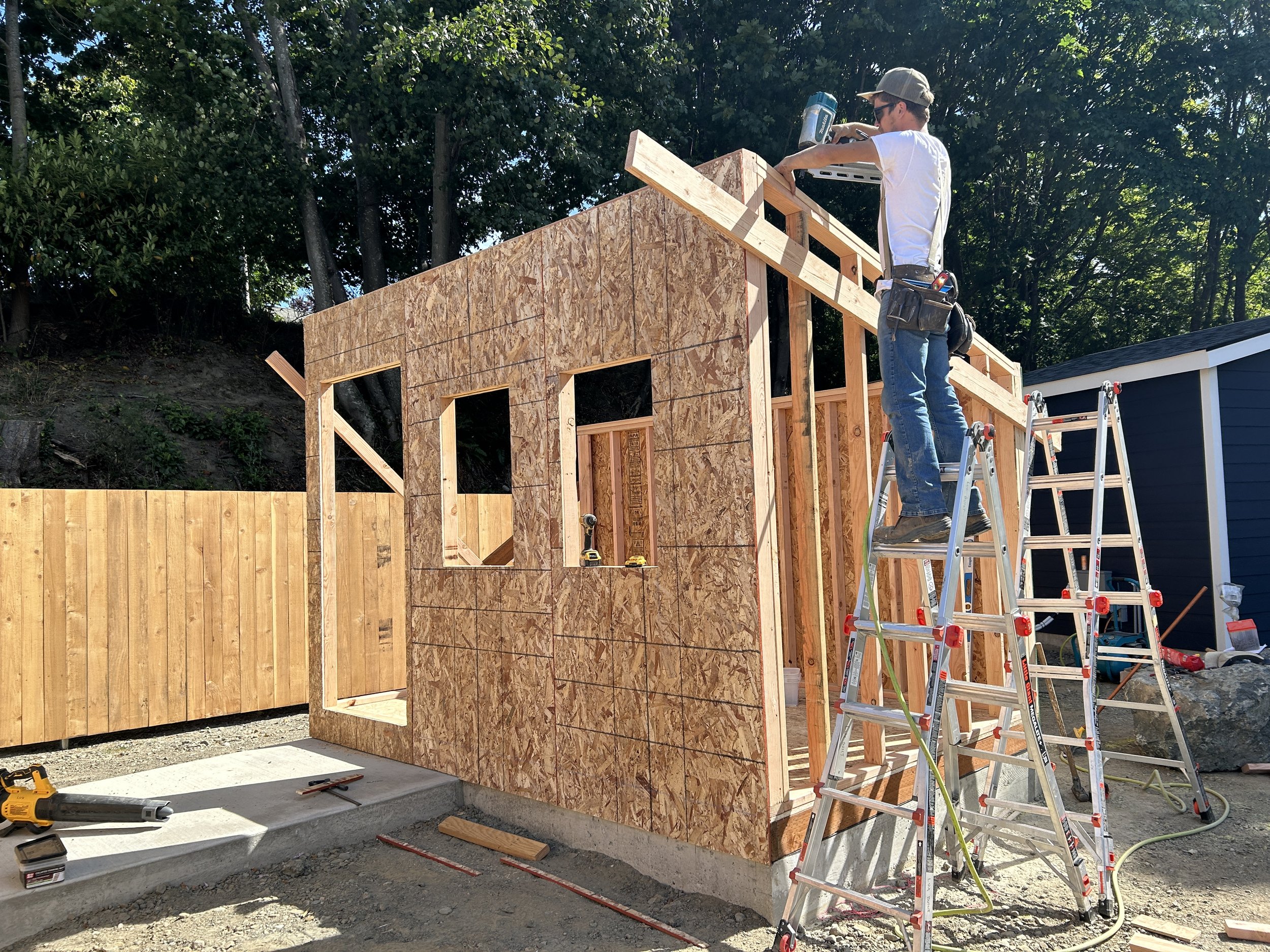

  • Construct Transitional Shelters

Estimated completion date: end of 2026

Cost: $31,000/unit

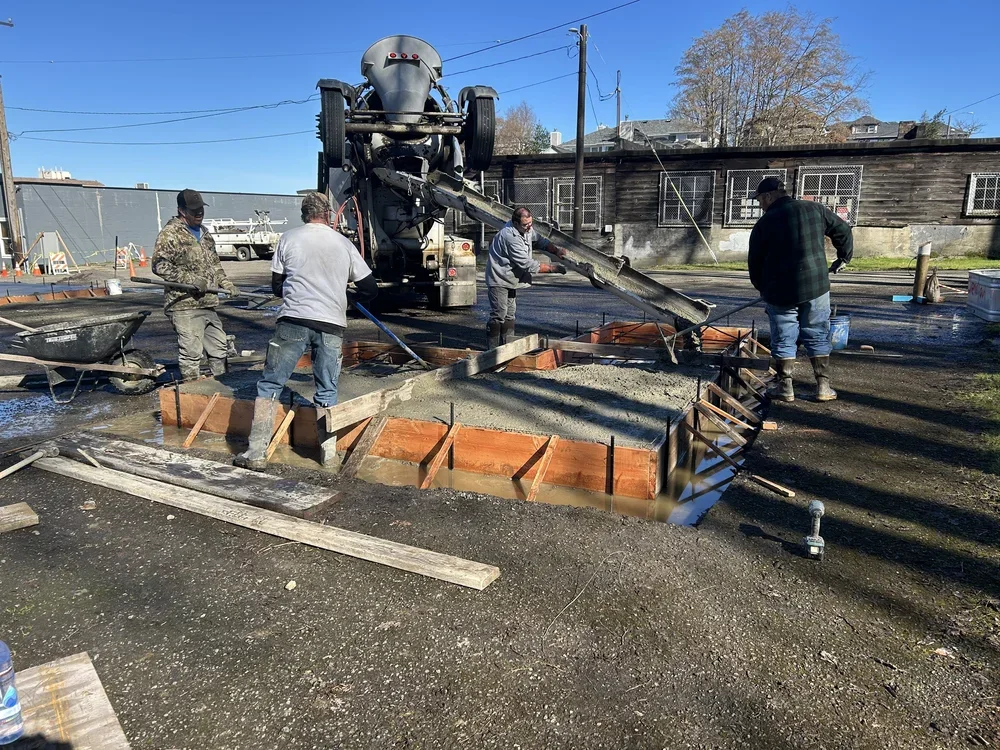

All permits have been attained through the city of Port Angeles and ground was broken January 2025.

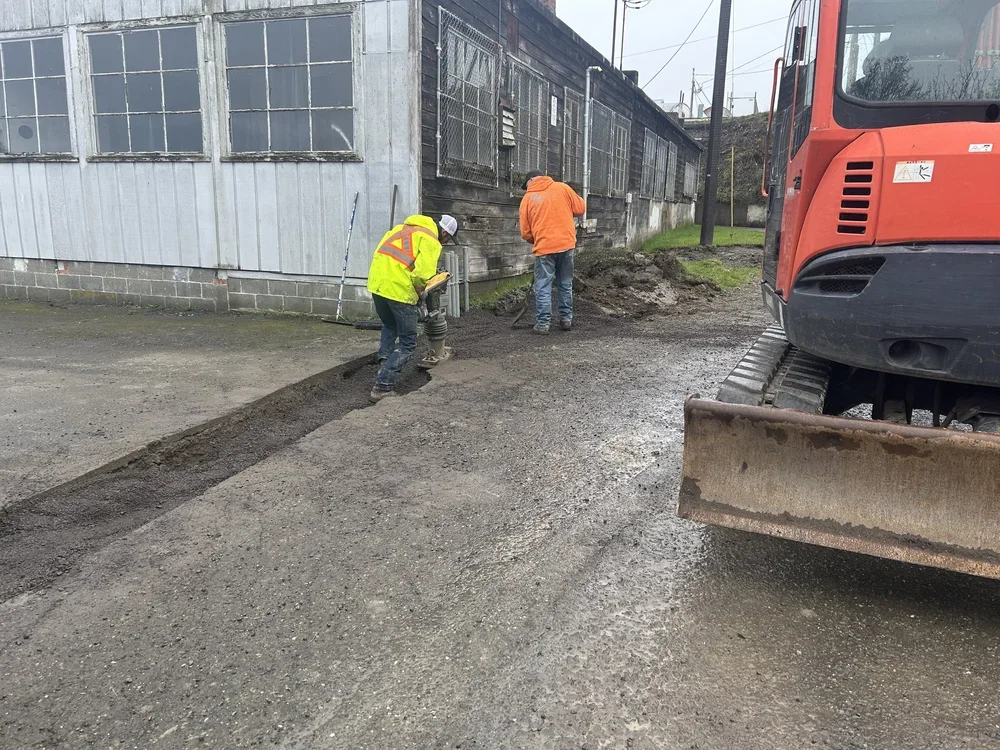

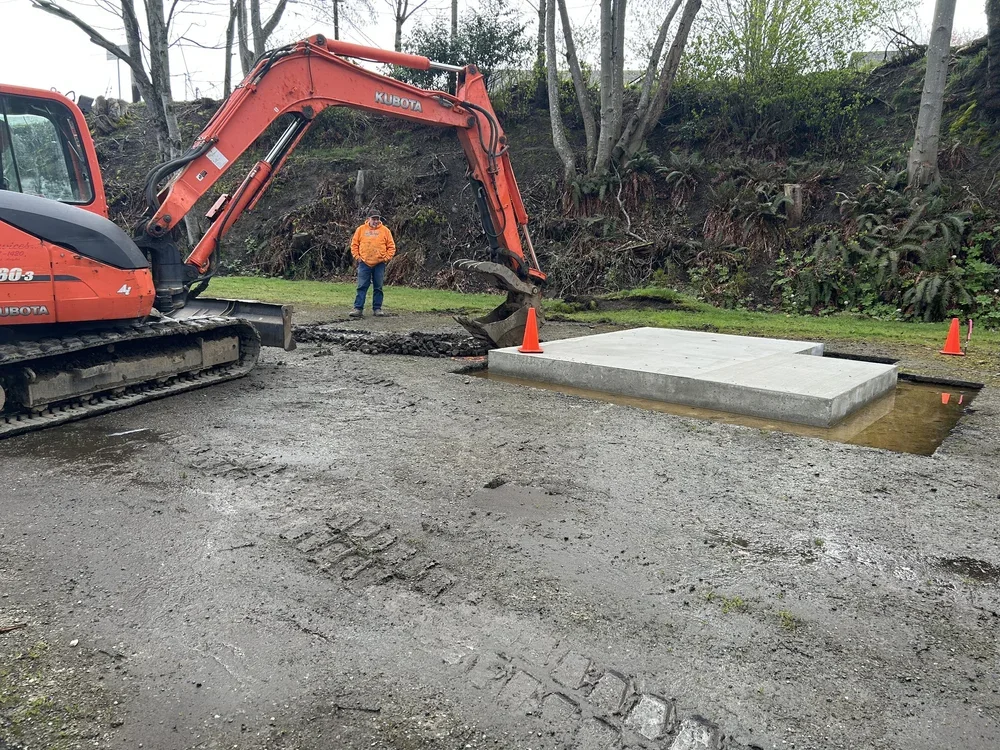

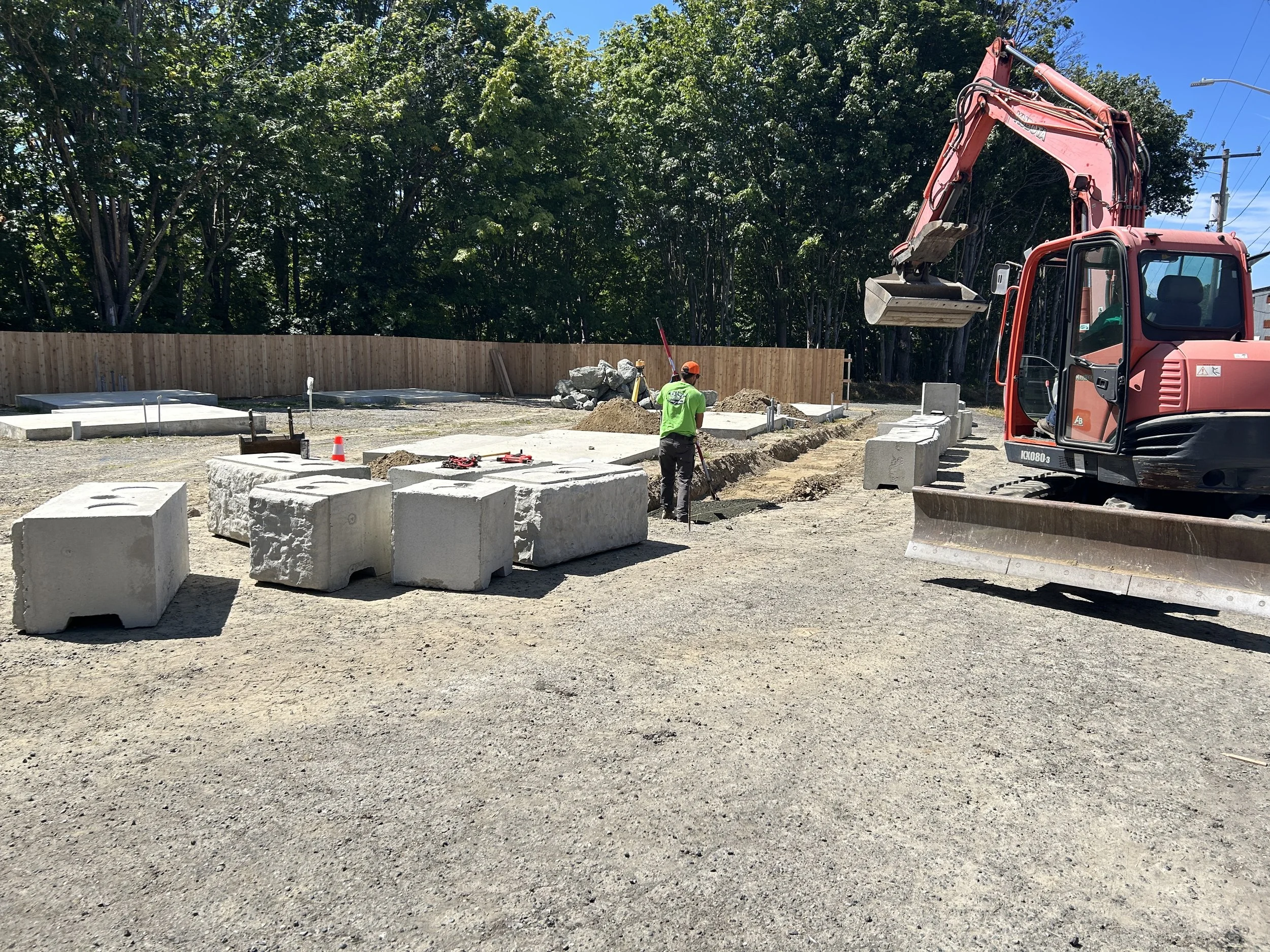

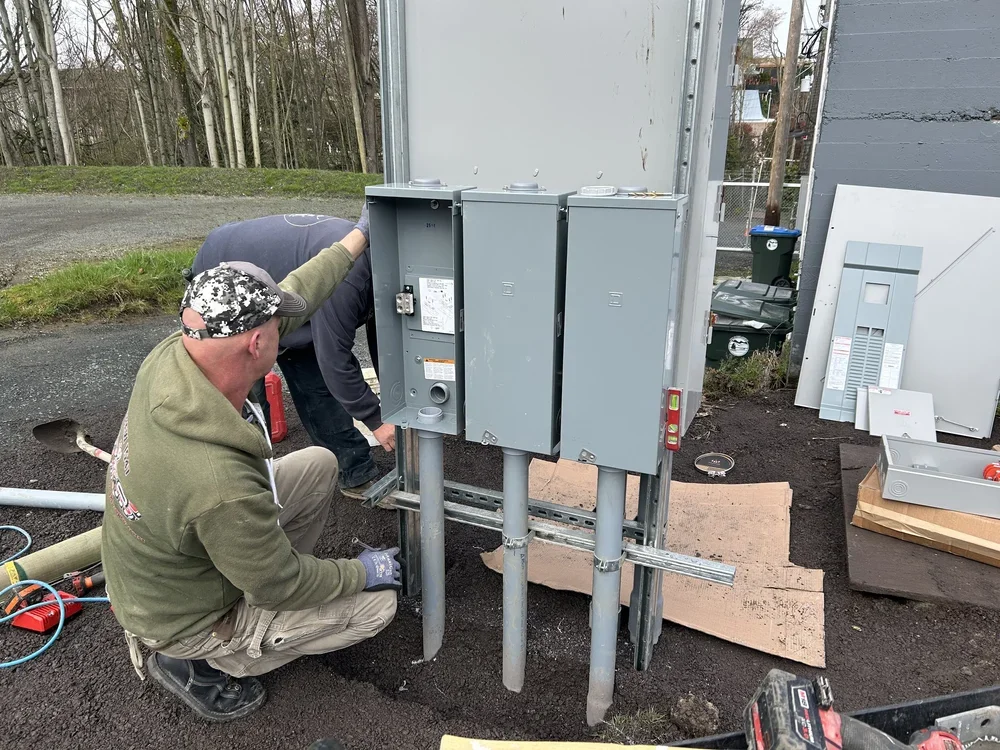

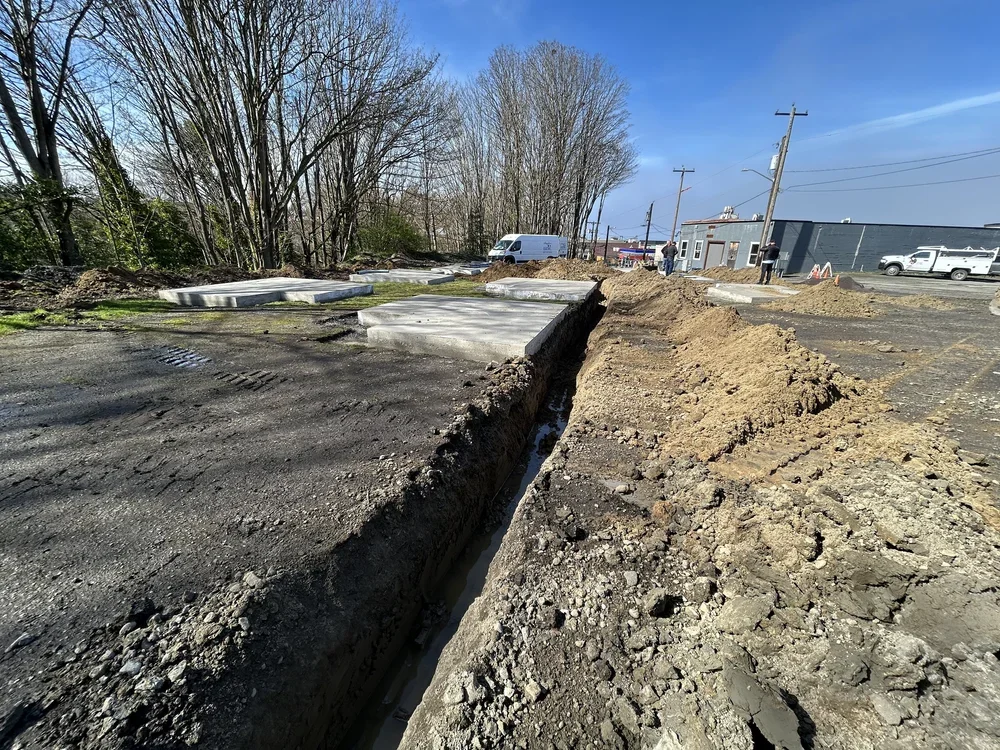

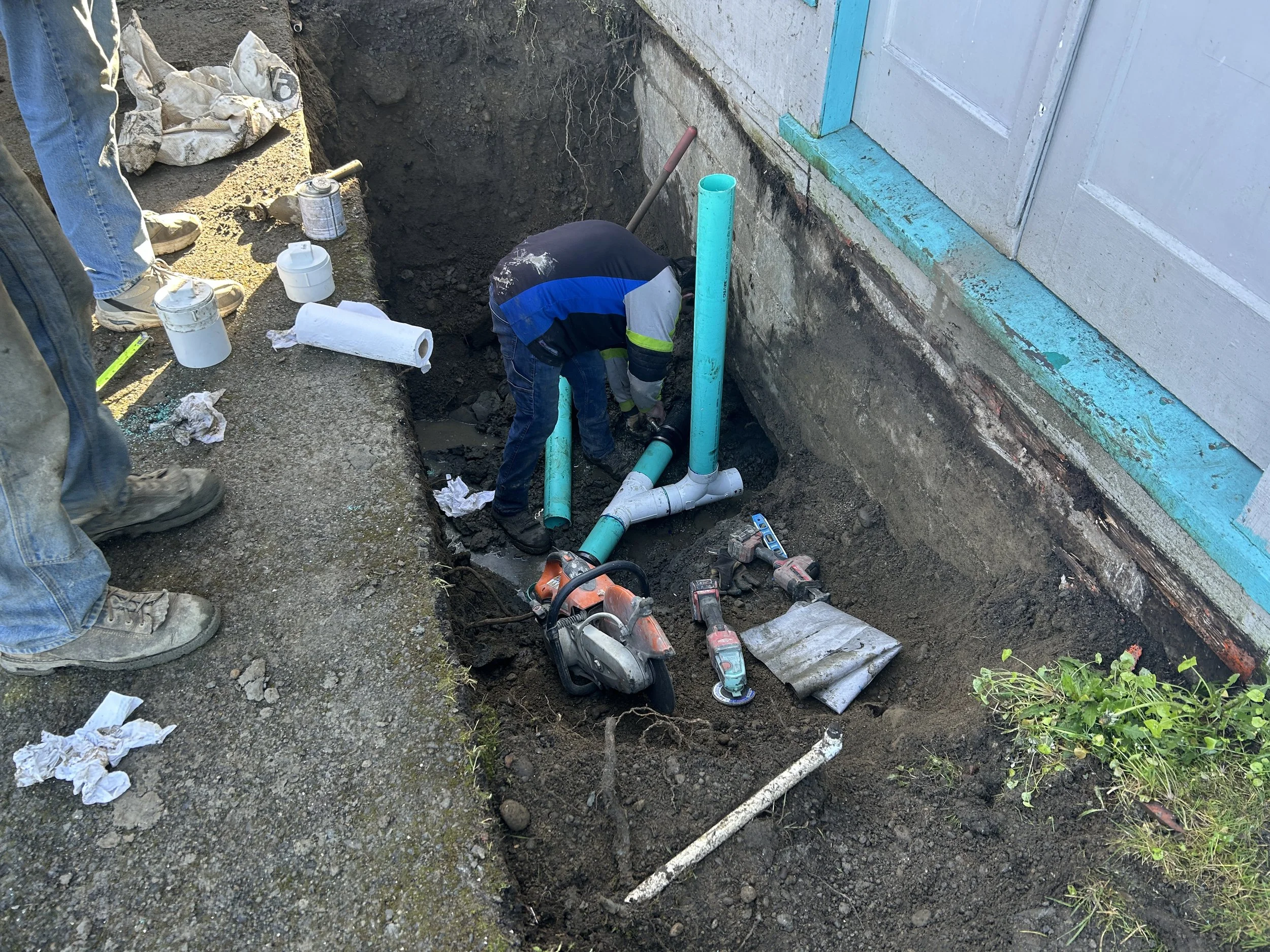

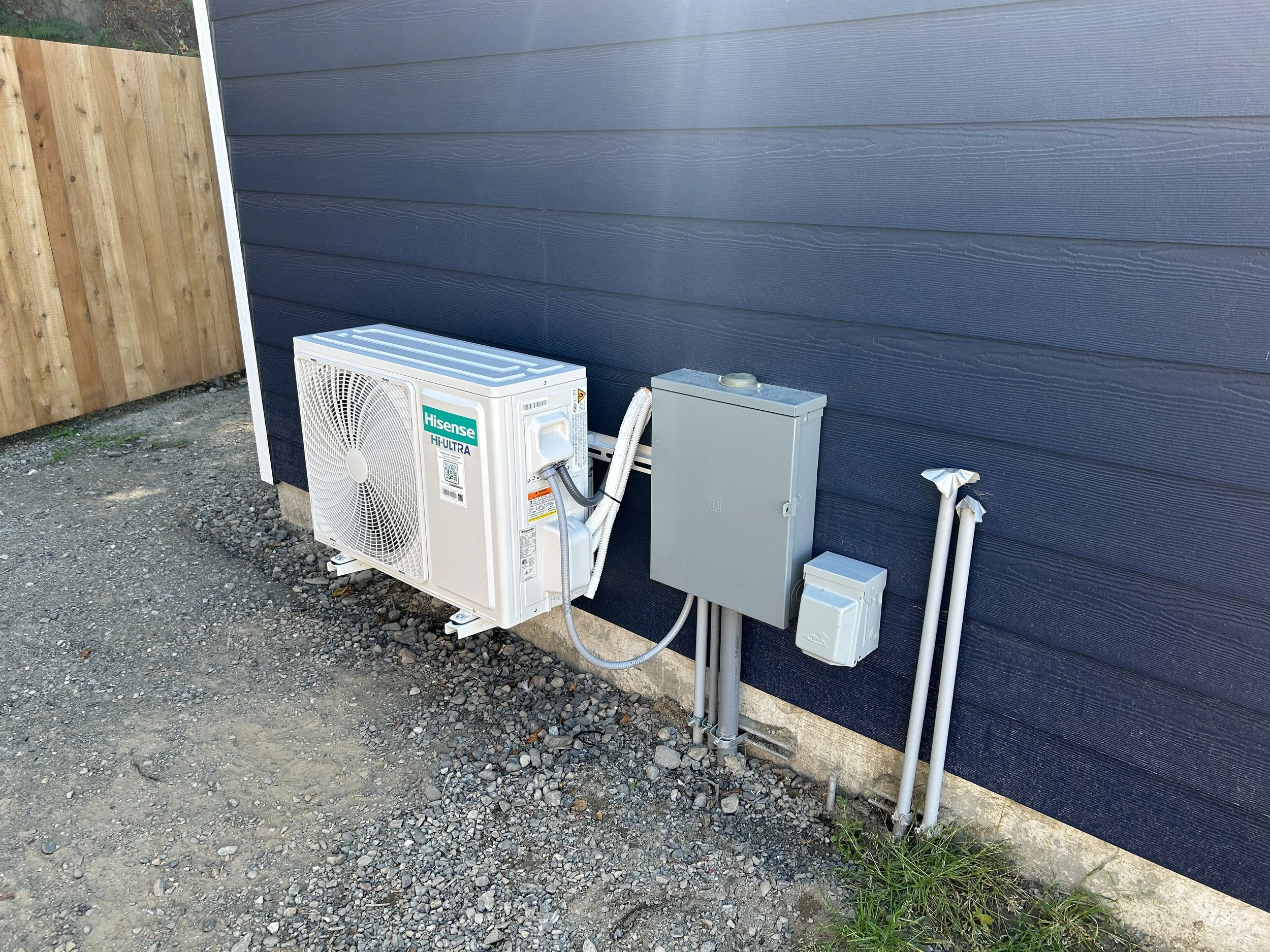

The first part of this phase included site prep, underground utilities, and updated 3-phase electrical service that will power our entire campus.

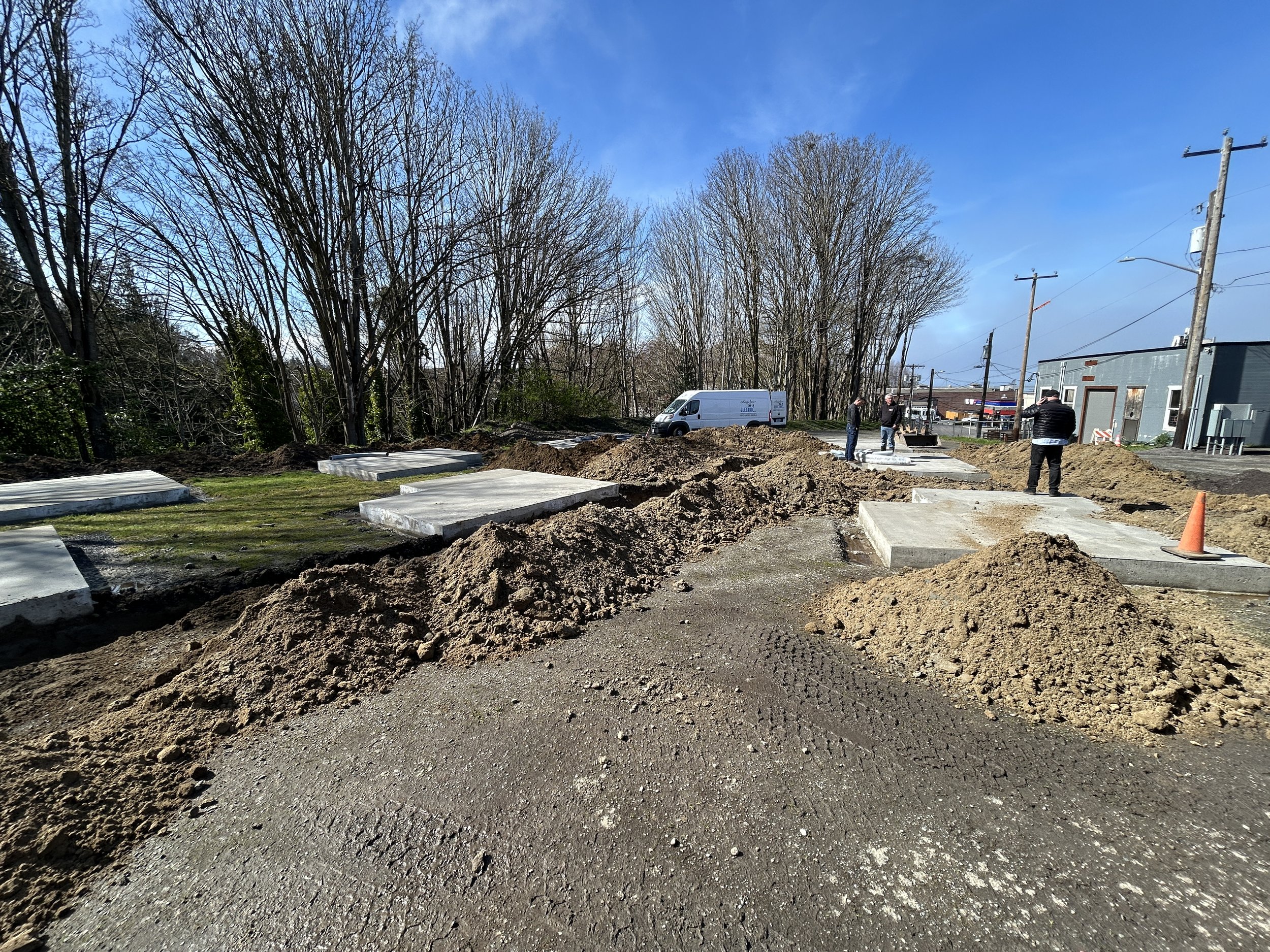

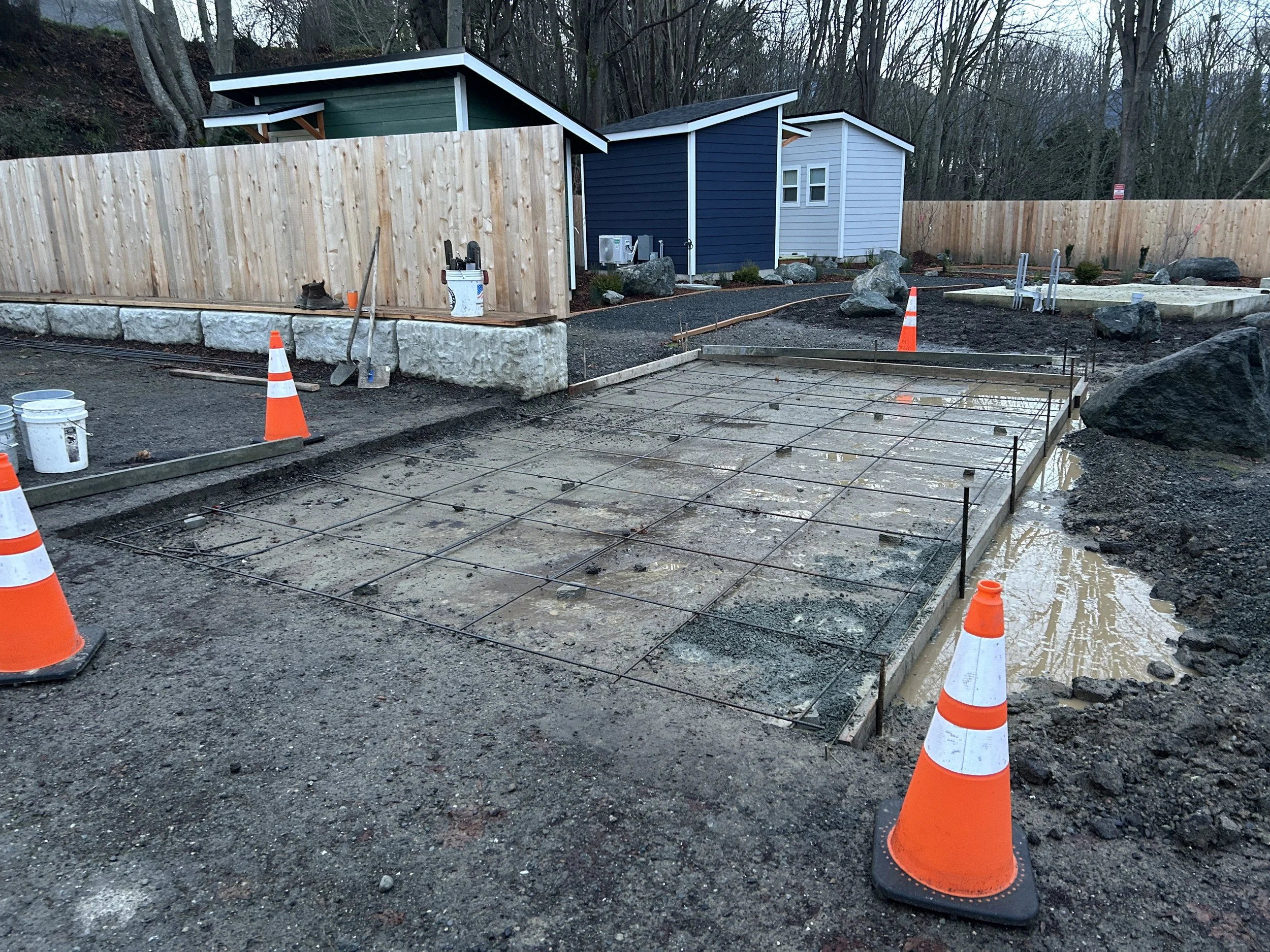

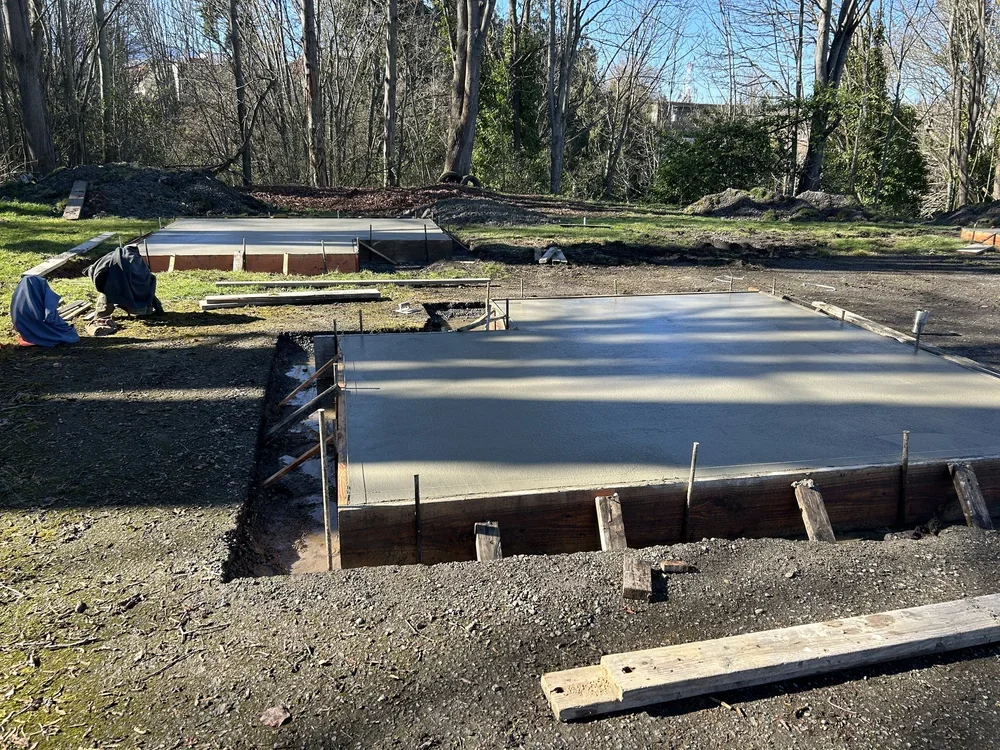

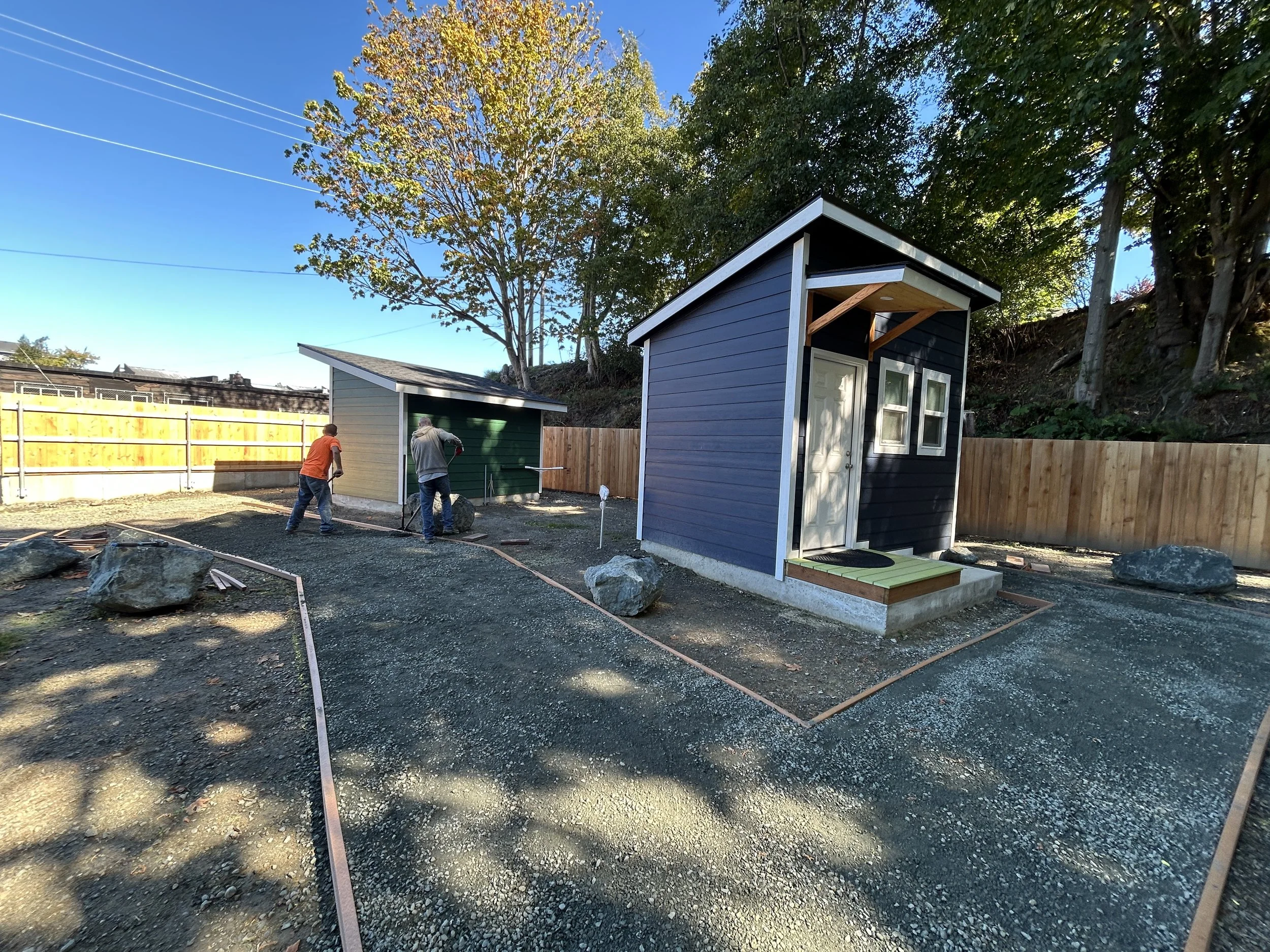

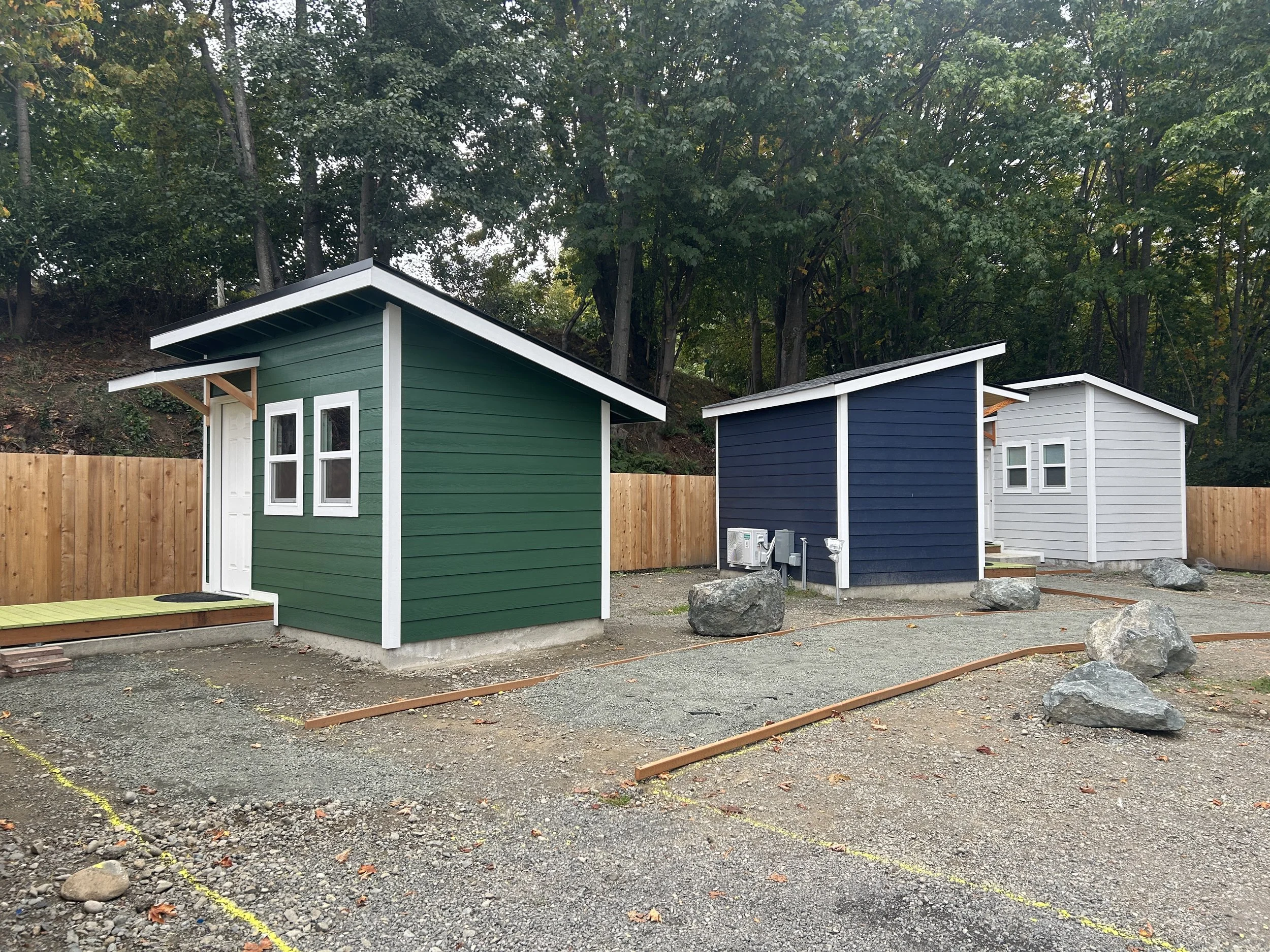

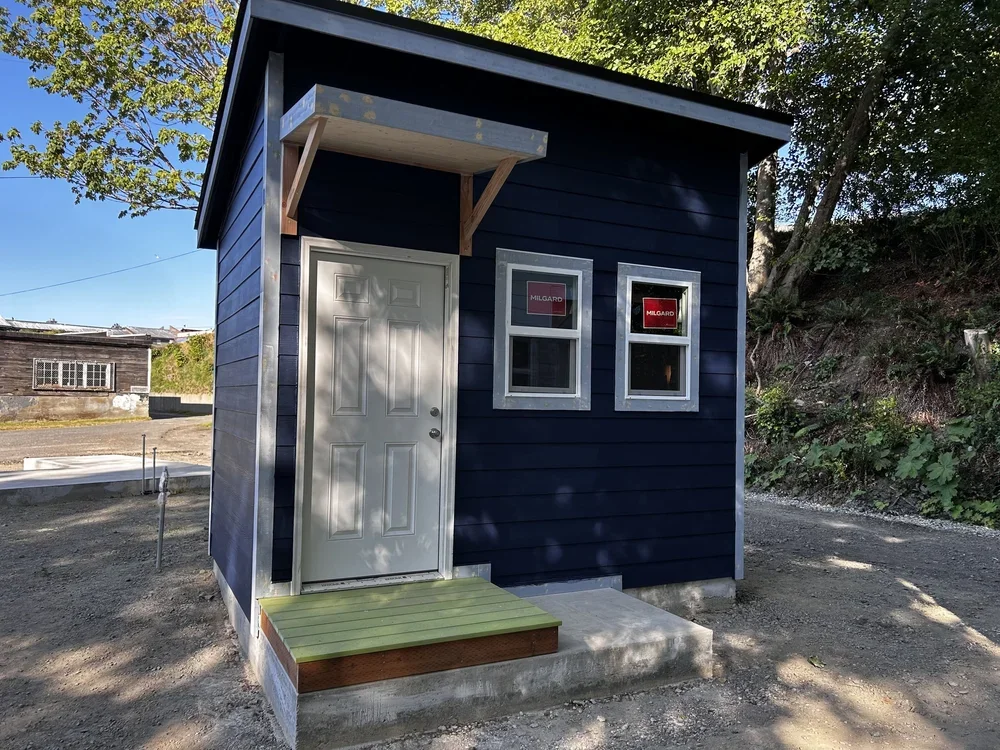

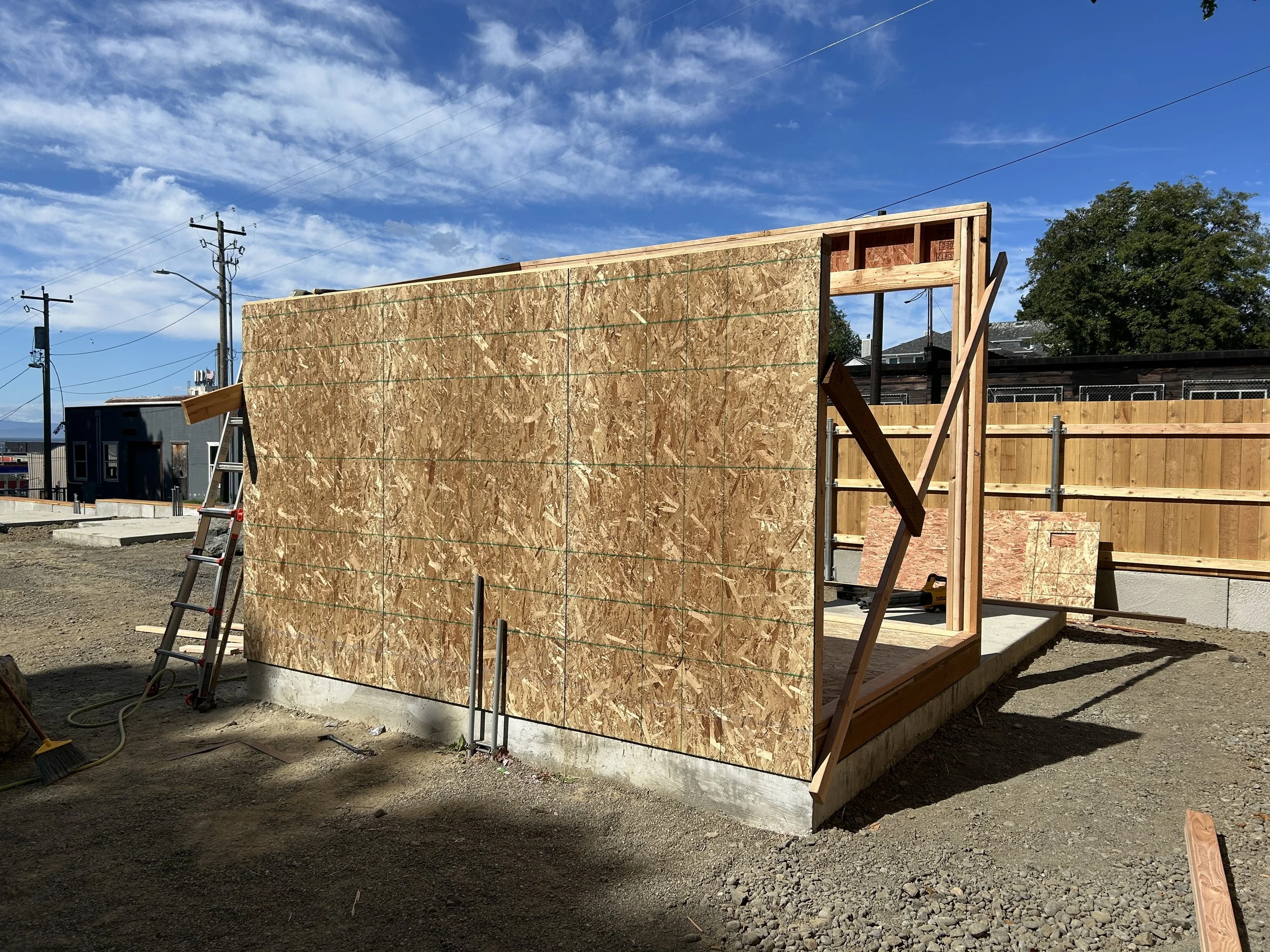

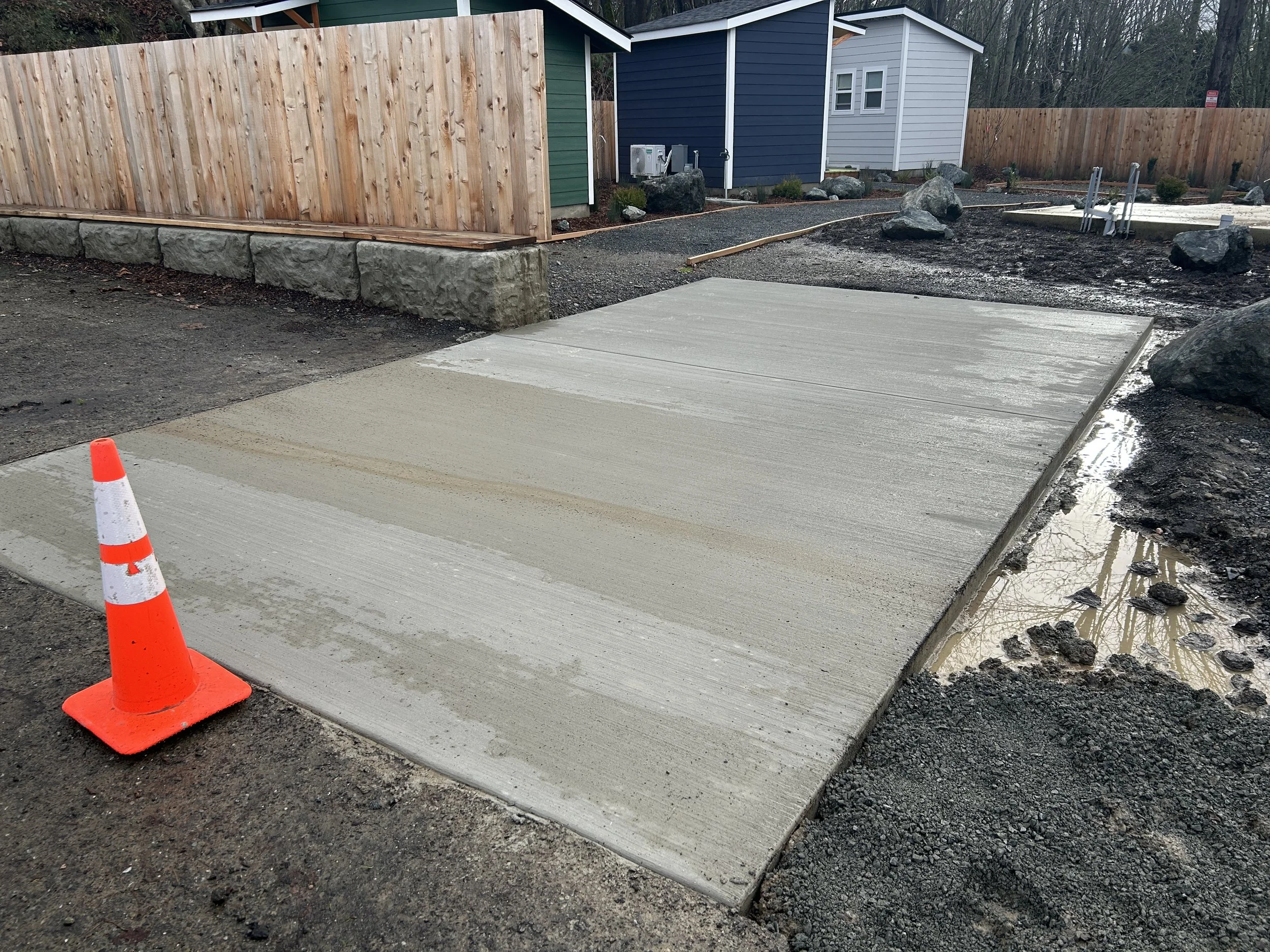

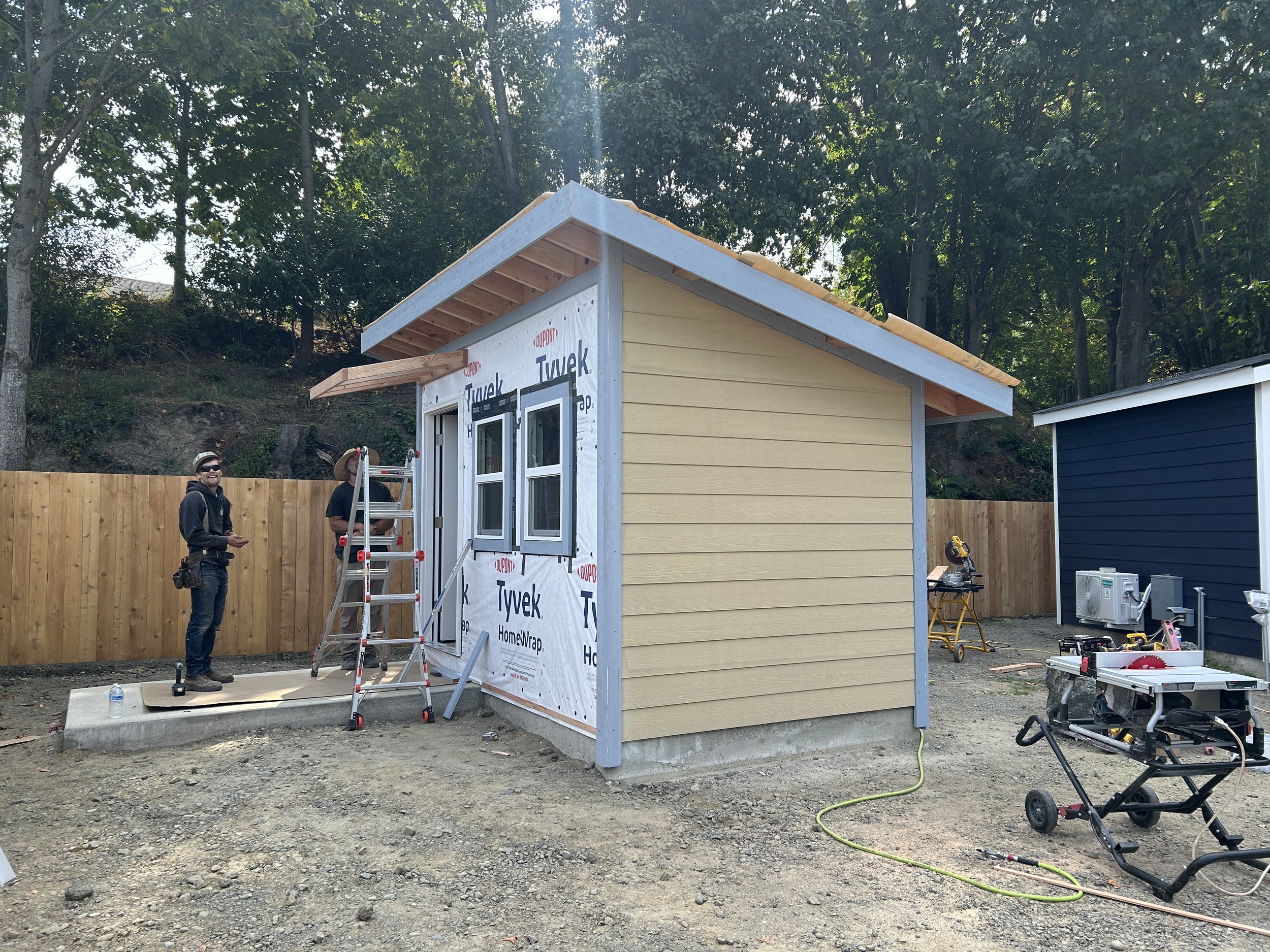

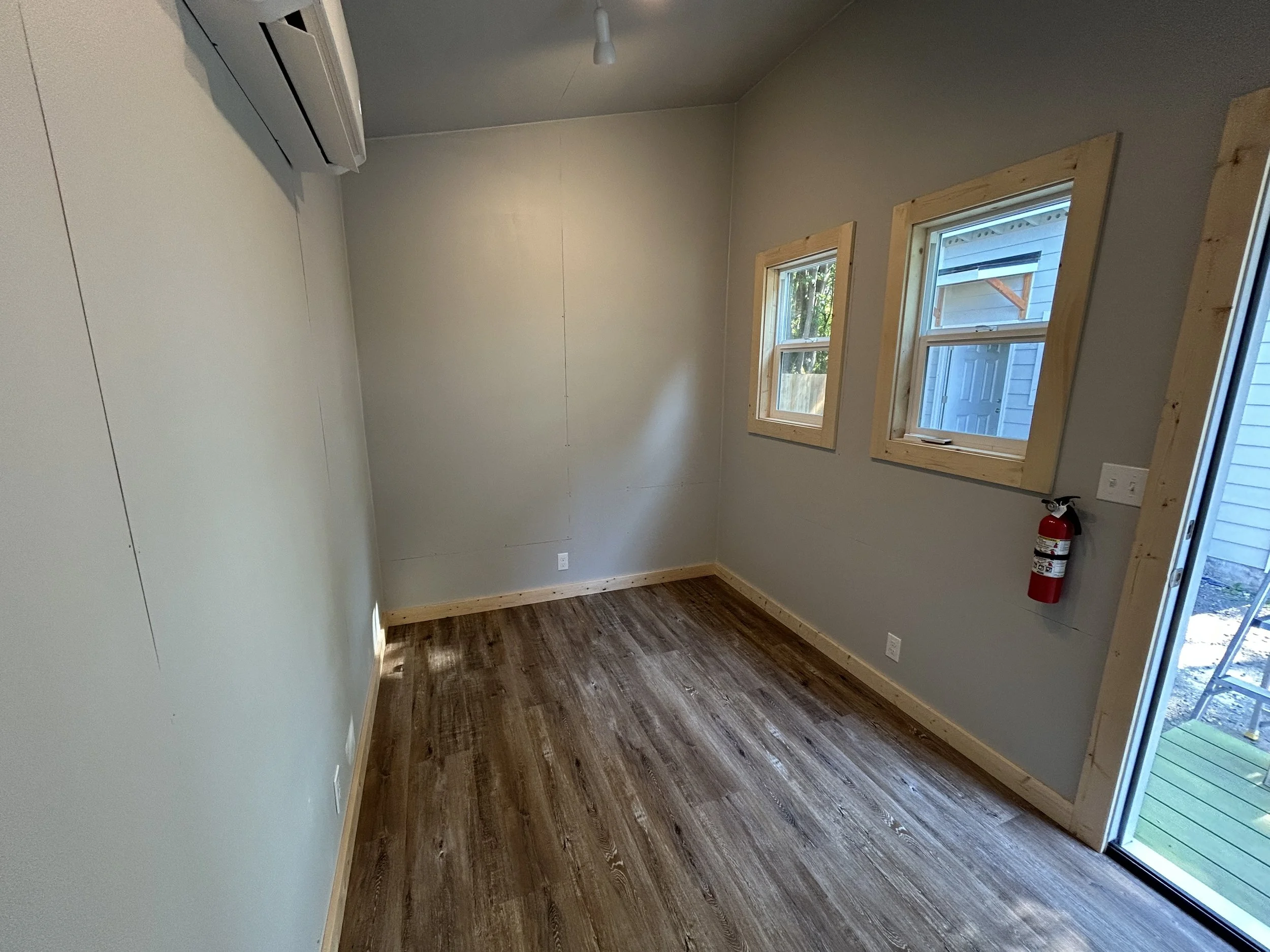

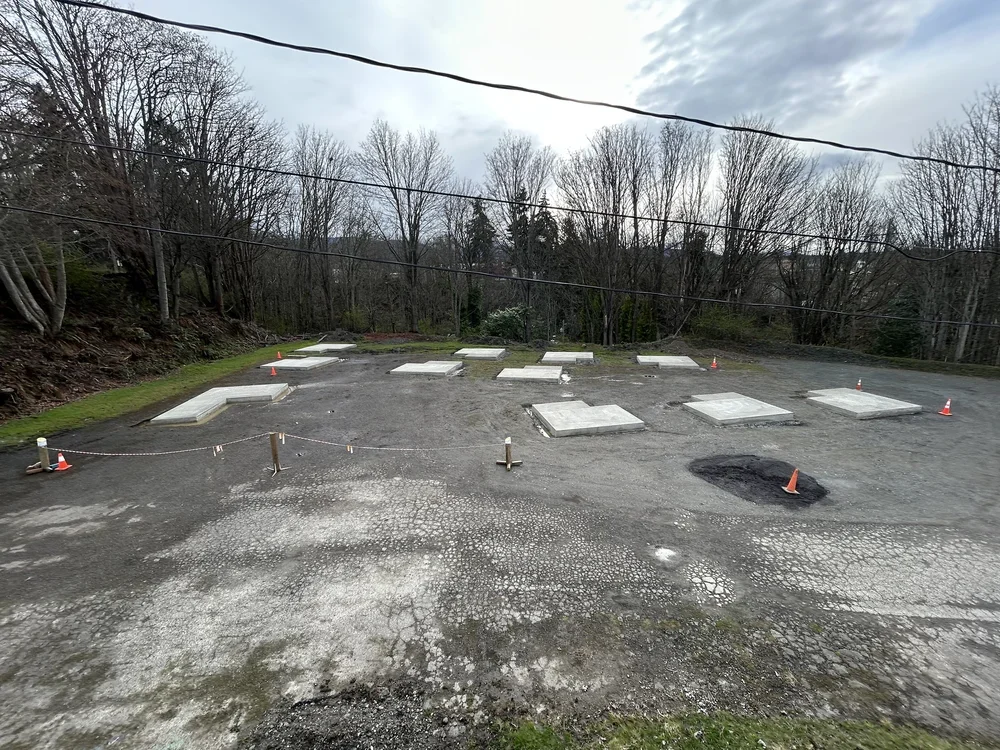

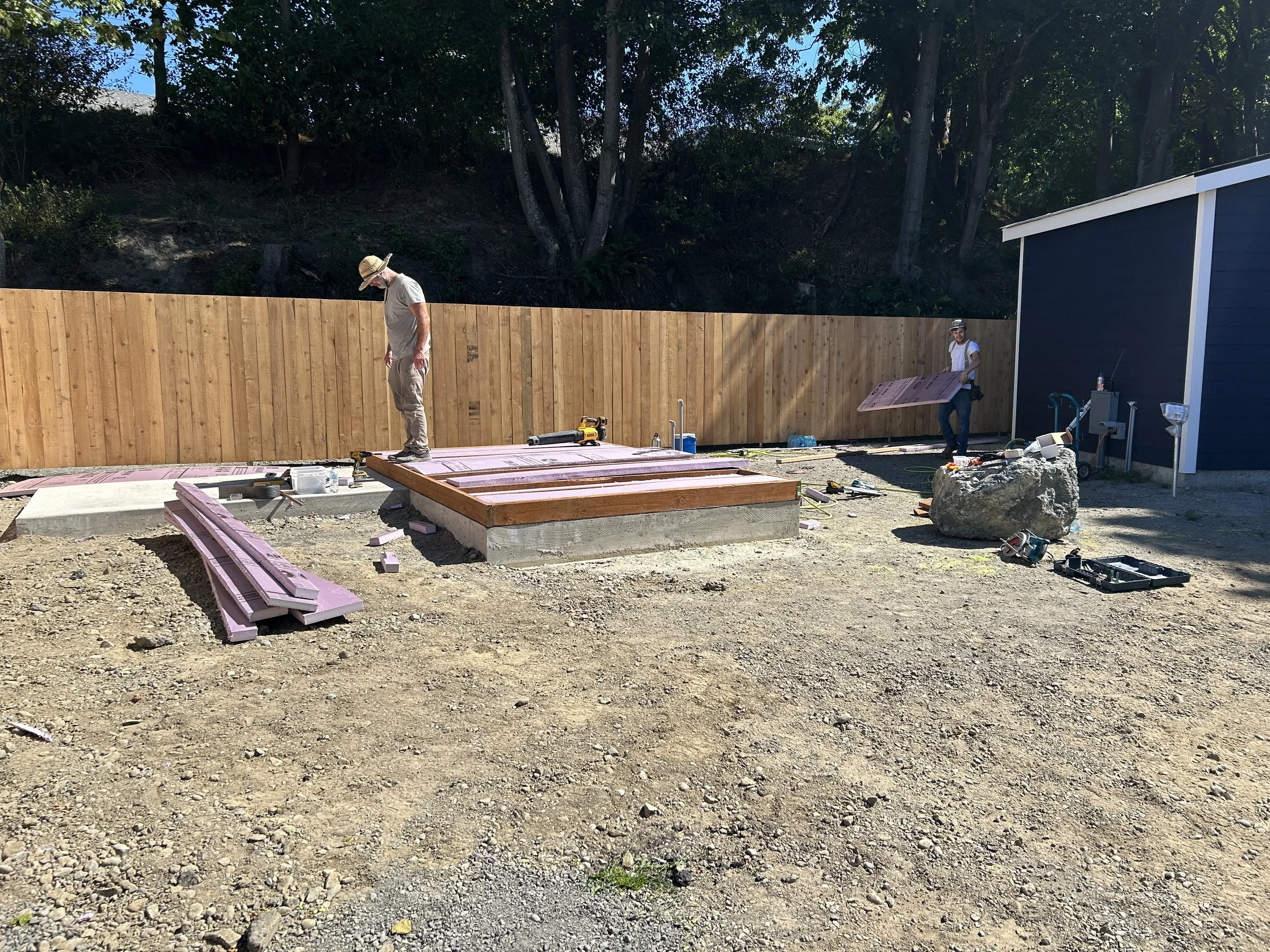

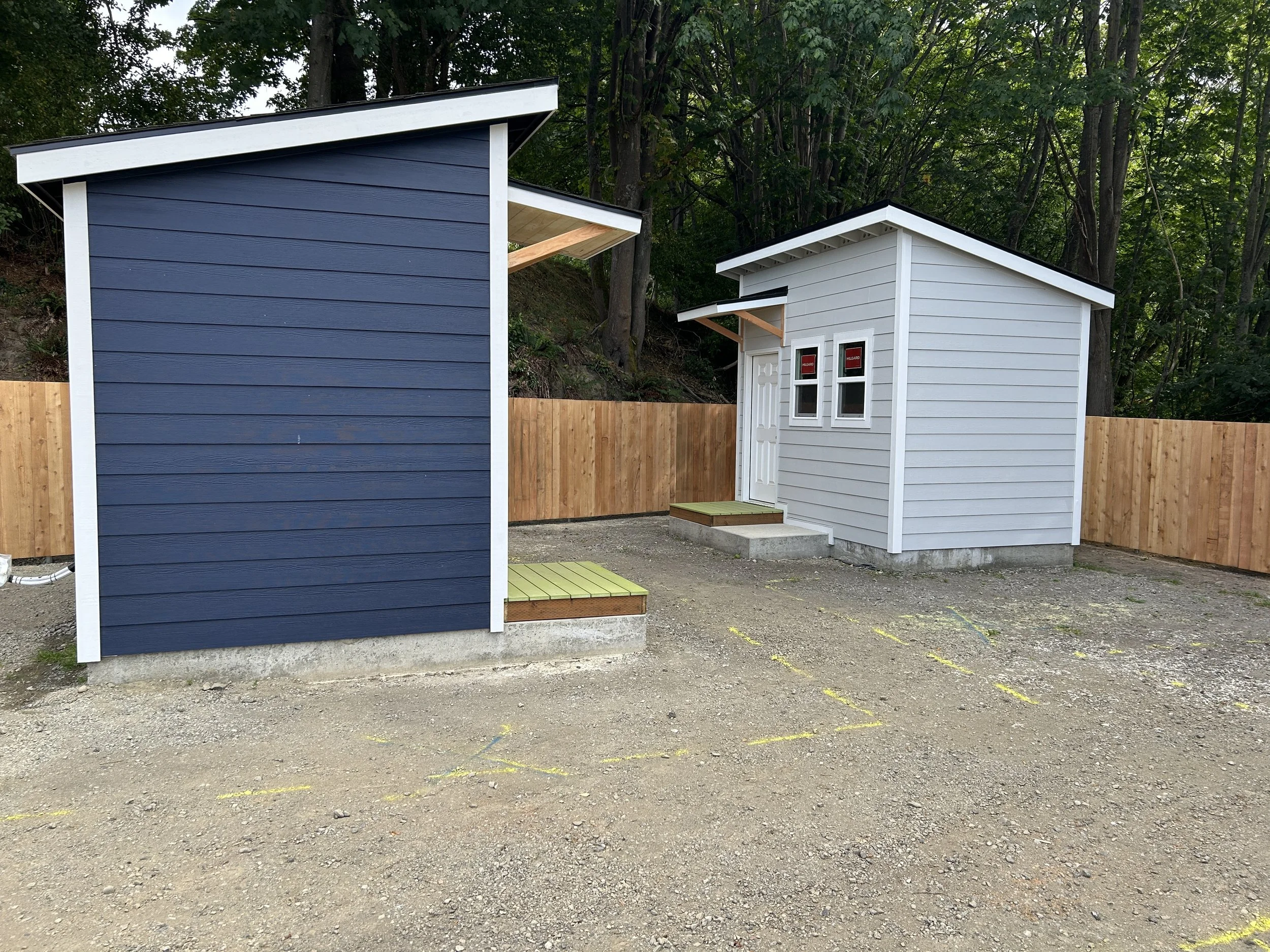

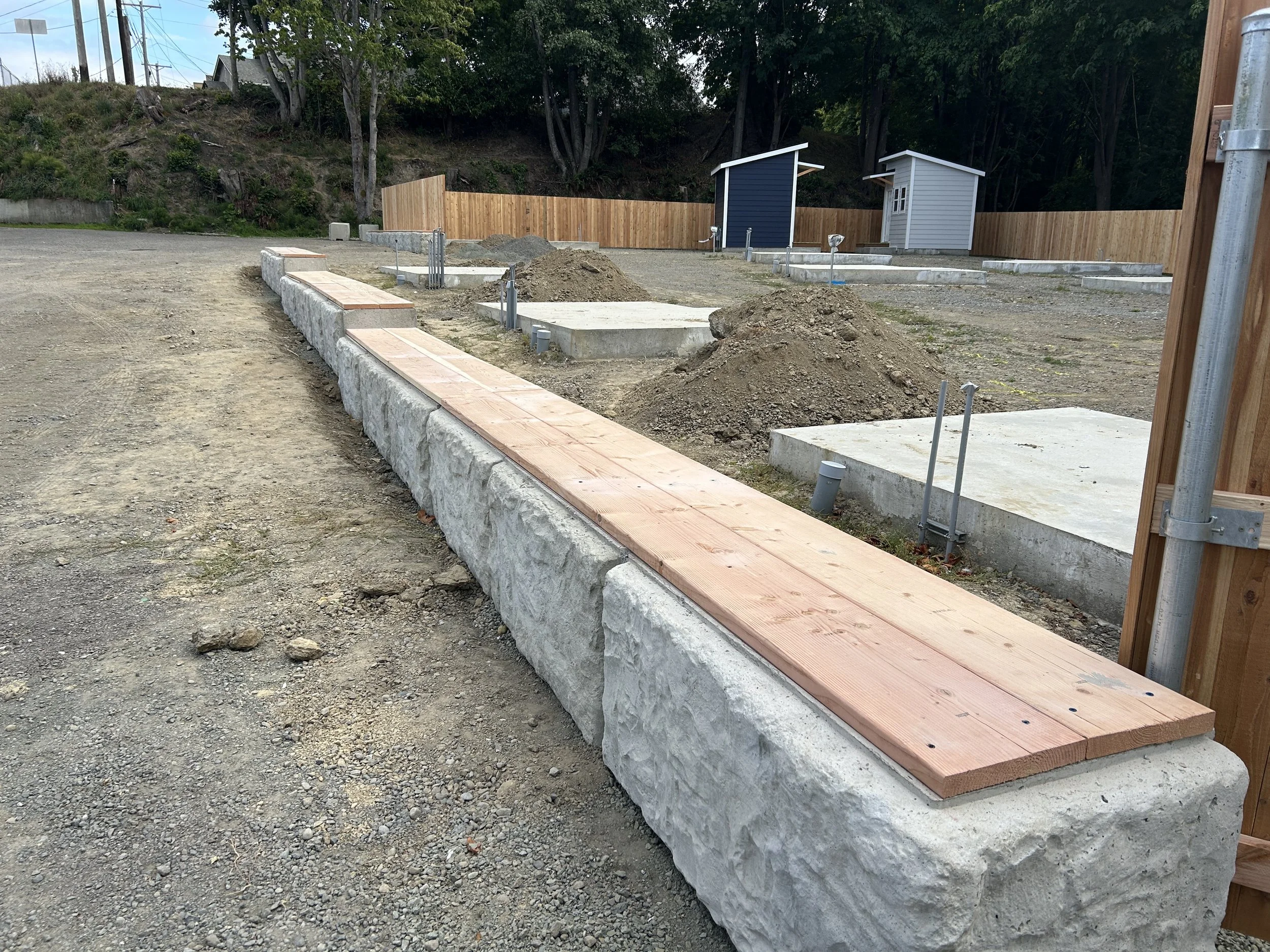

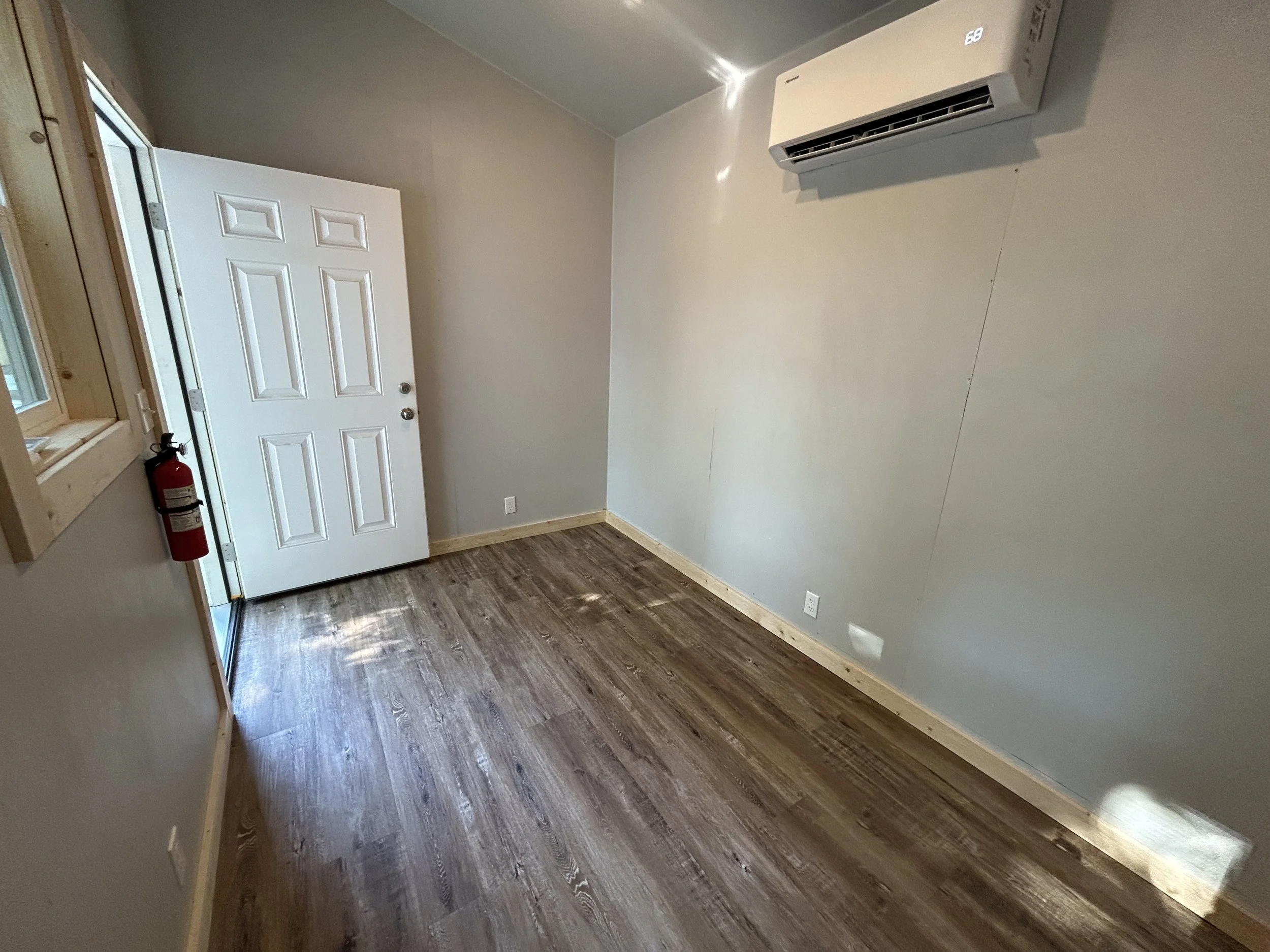

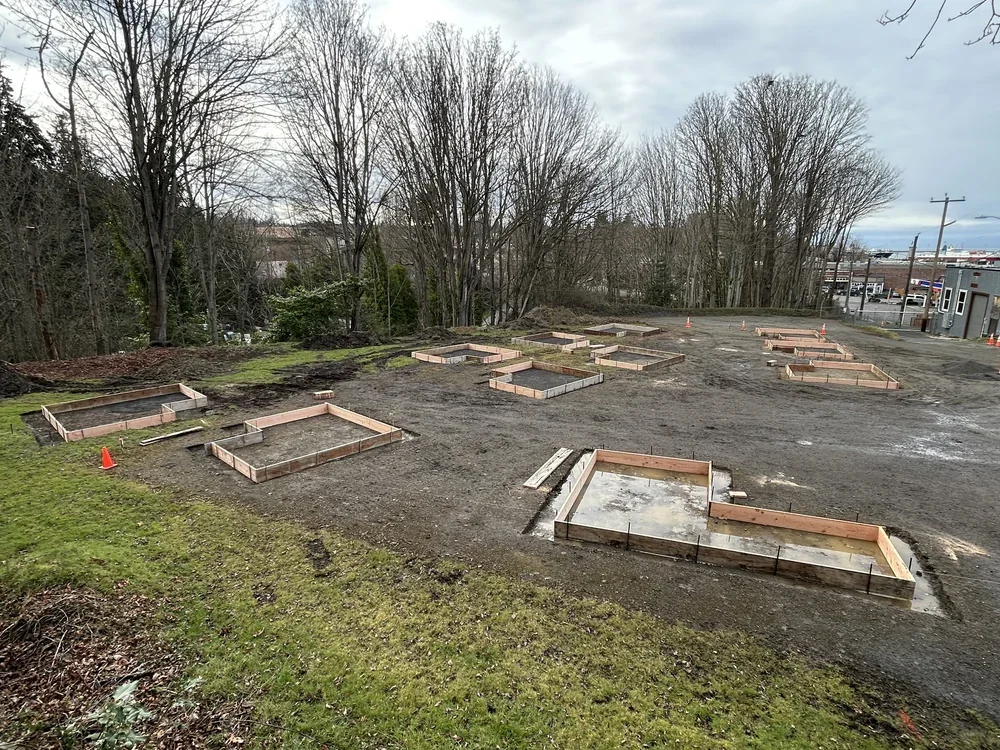

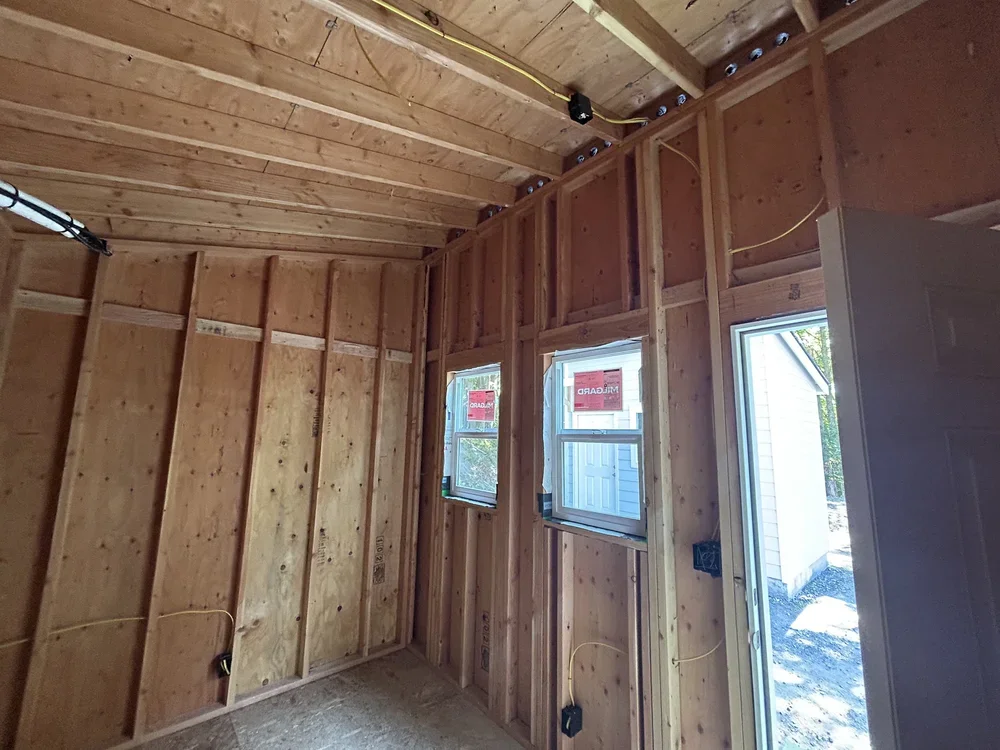

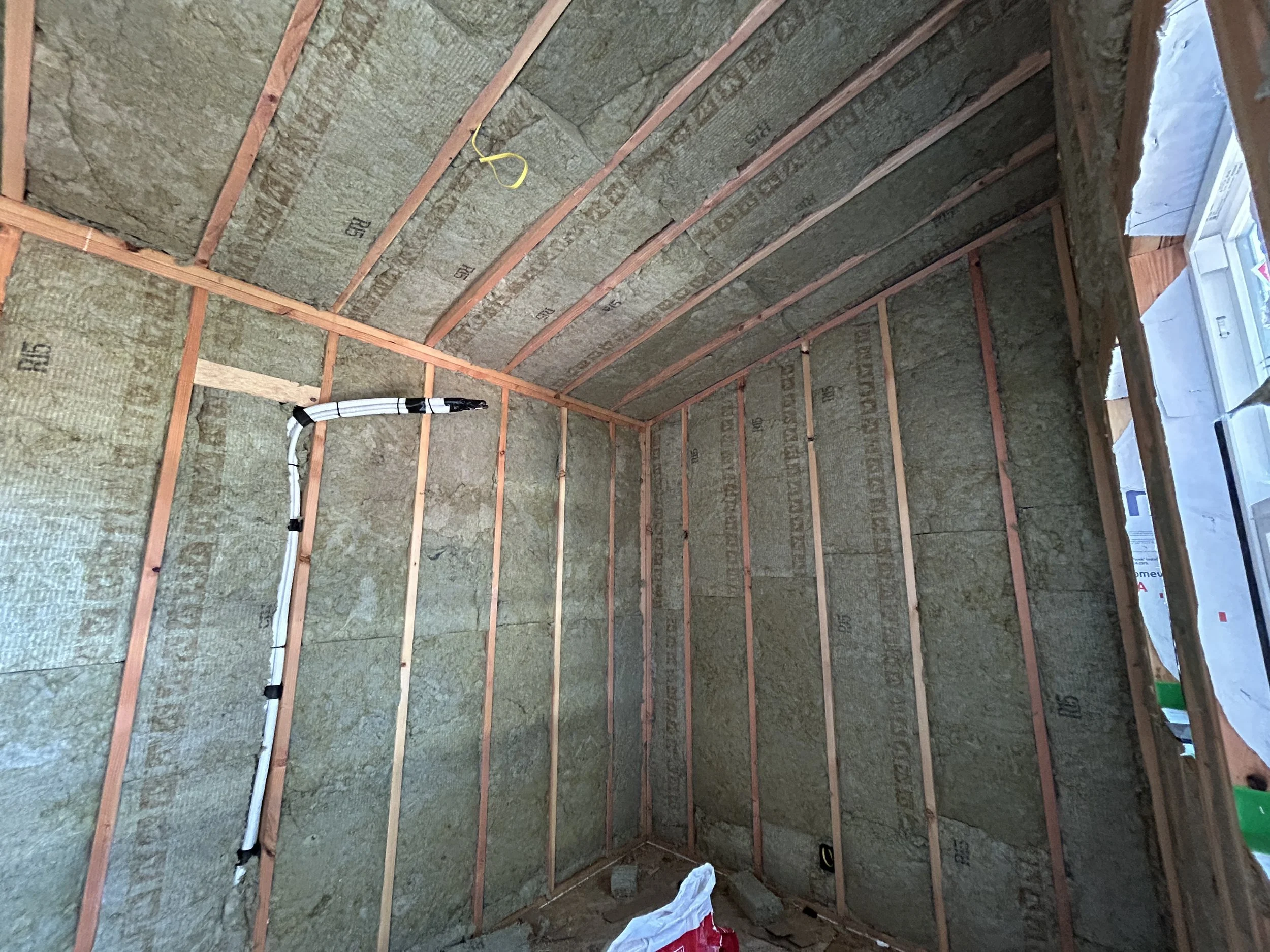

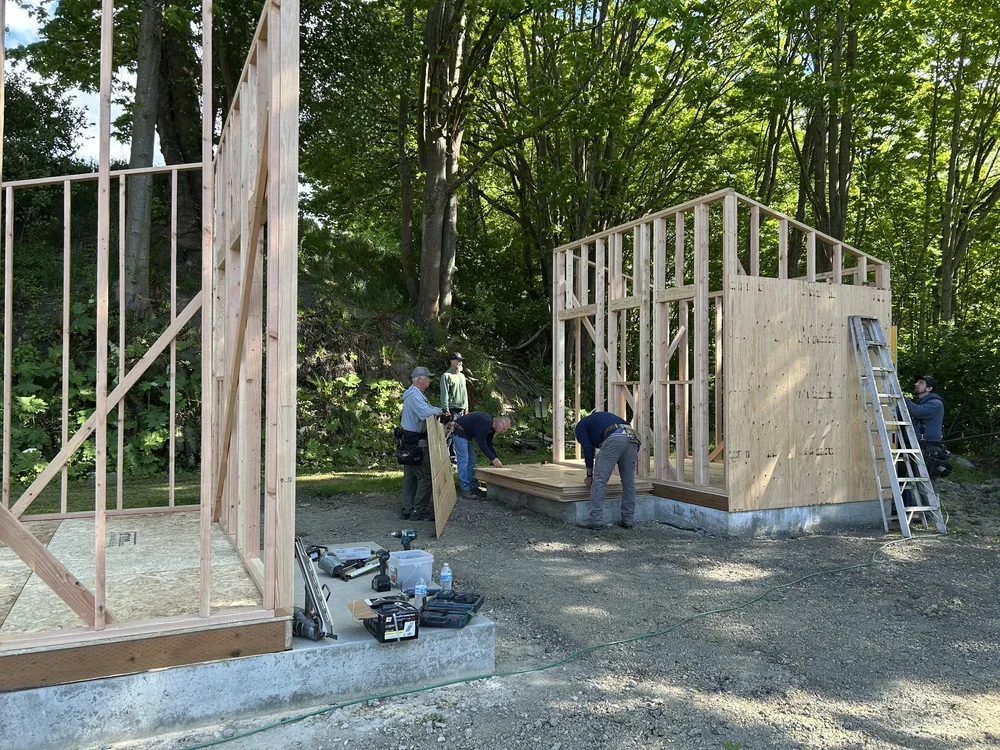

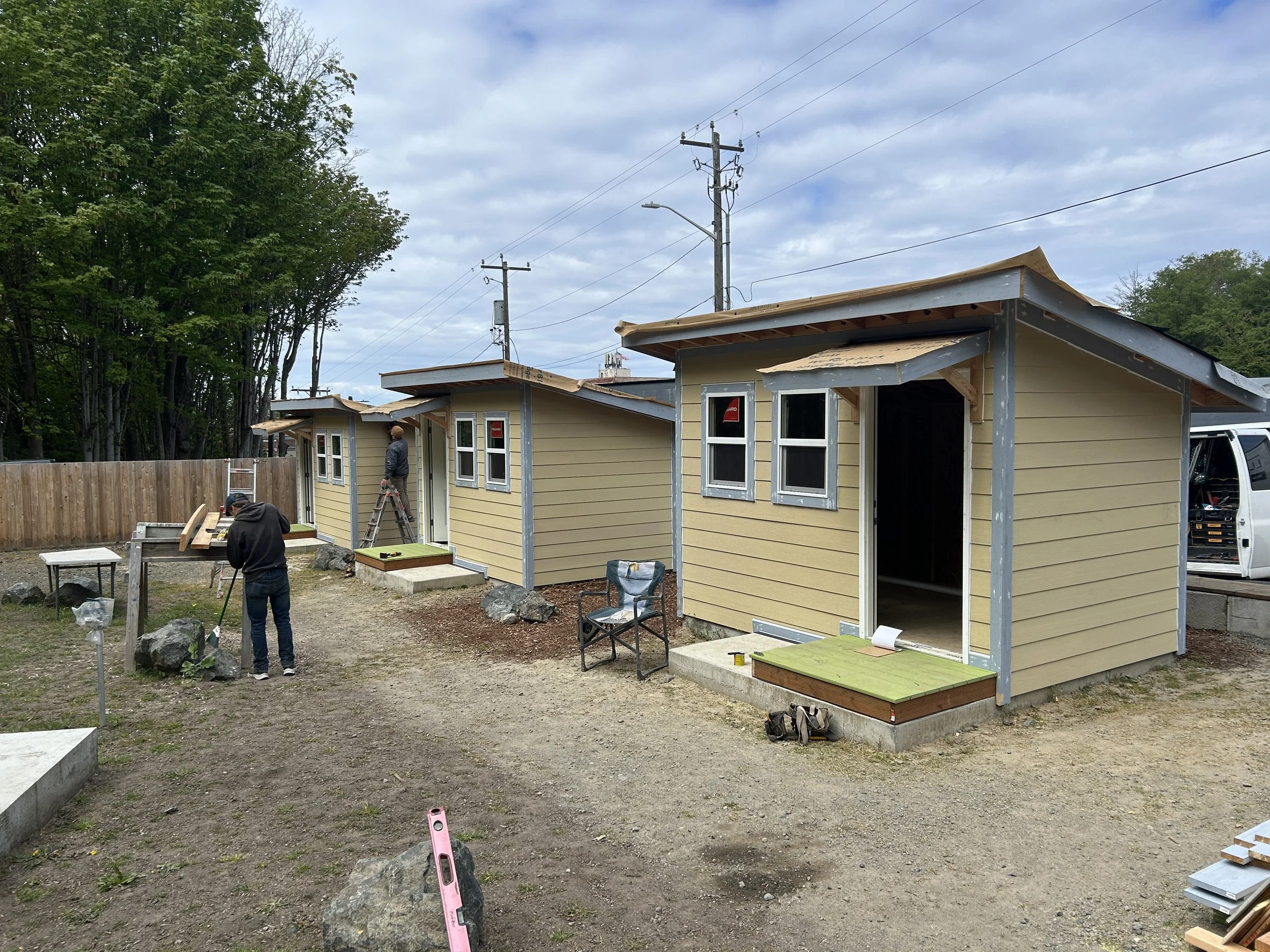

As a cost saving measure, all eleven foundations were poured at once in preparation for future shelters. Currently, 3 units have been completed and occupied including our on-site facilities manager.

Shelters will be built incrementally as we meet funding goals. Check back for application info (spring 2026)

Phase 3 :

  • Common Facilities

  • 4PA offices & conference room

Estimated completion date: end of 2026

Cost: $998,000

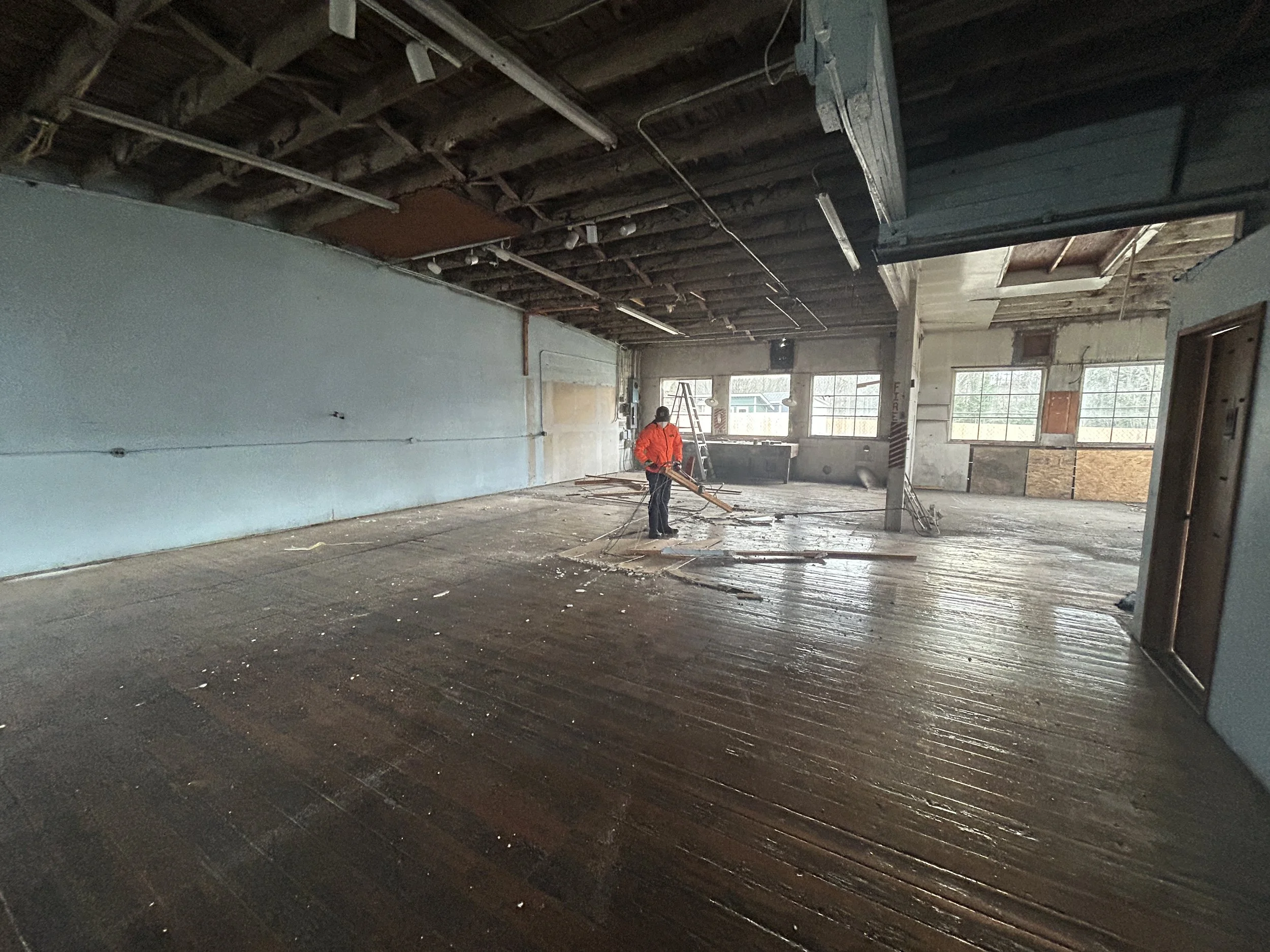

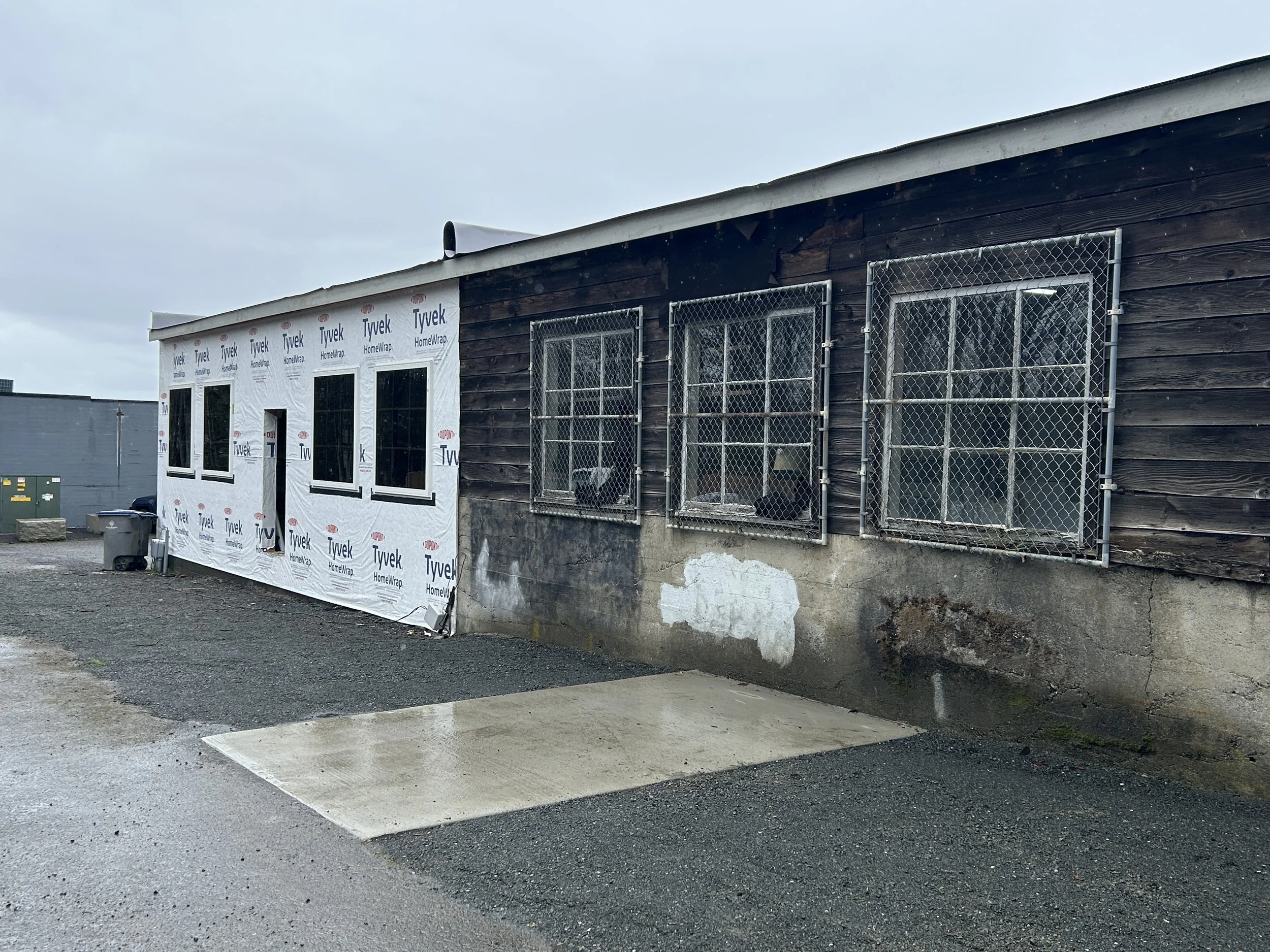

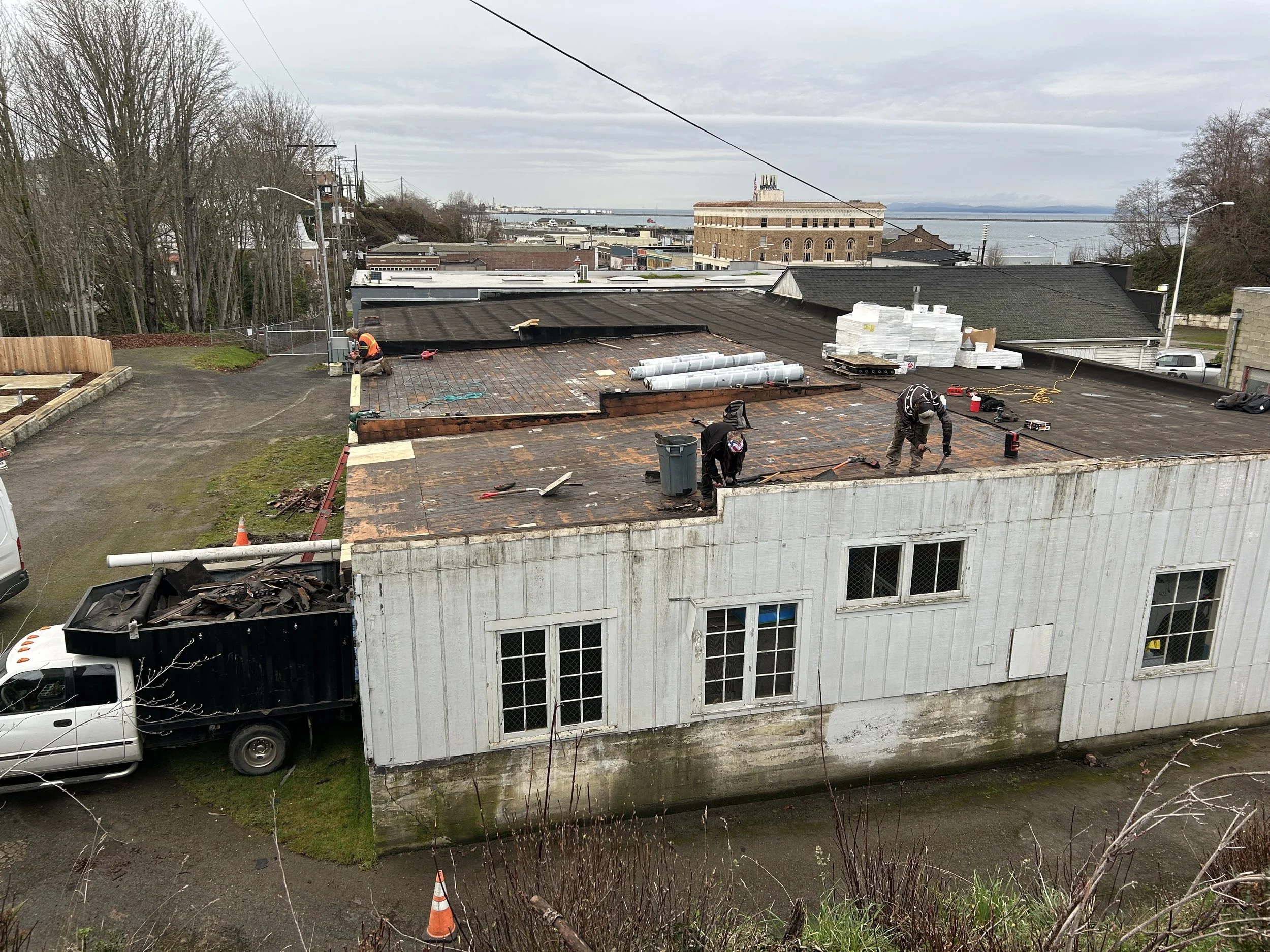

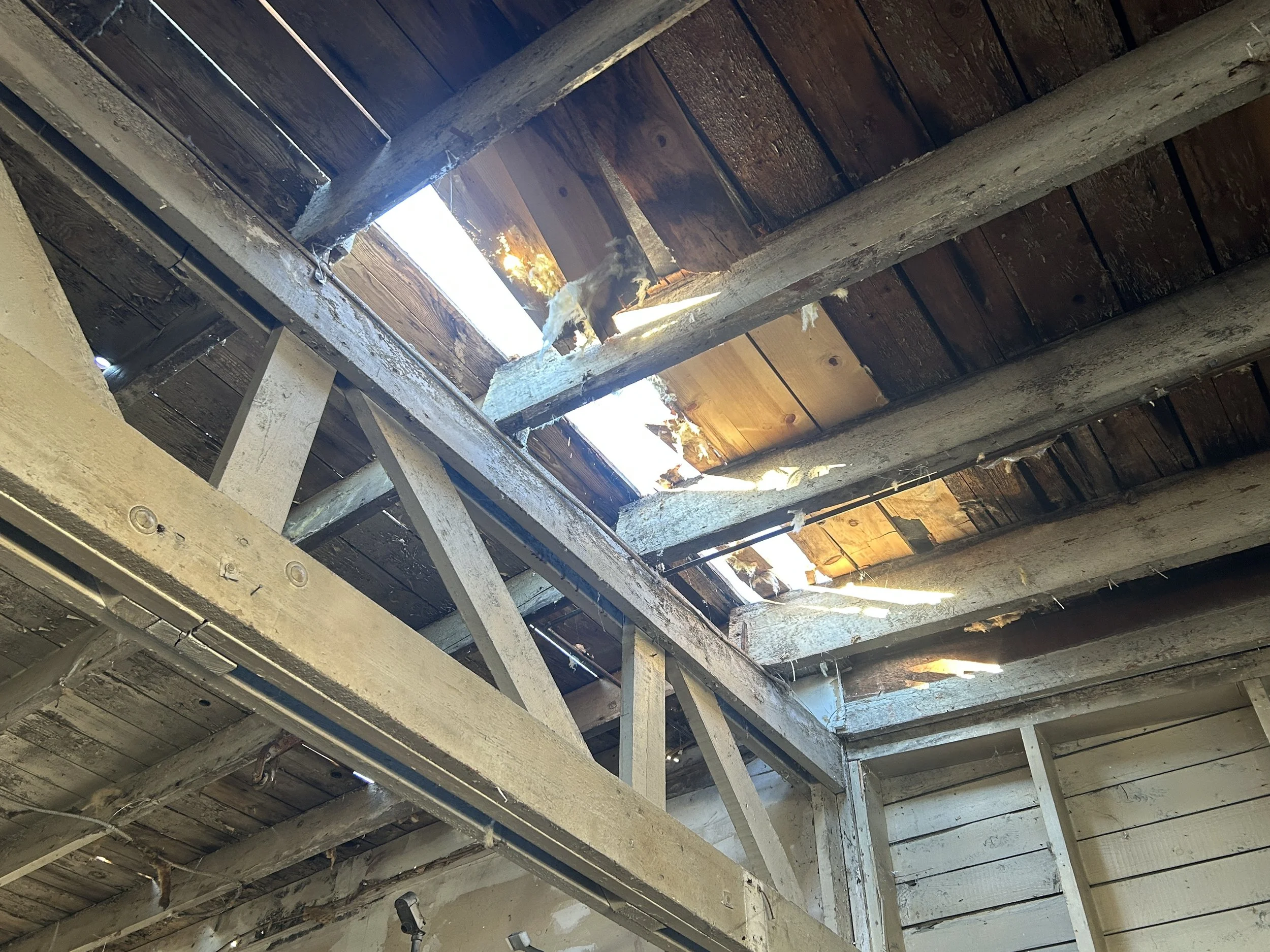

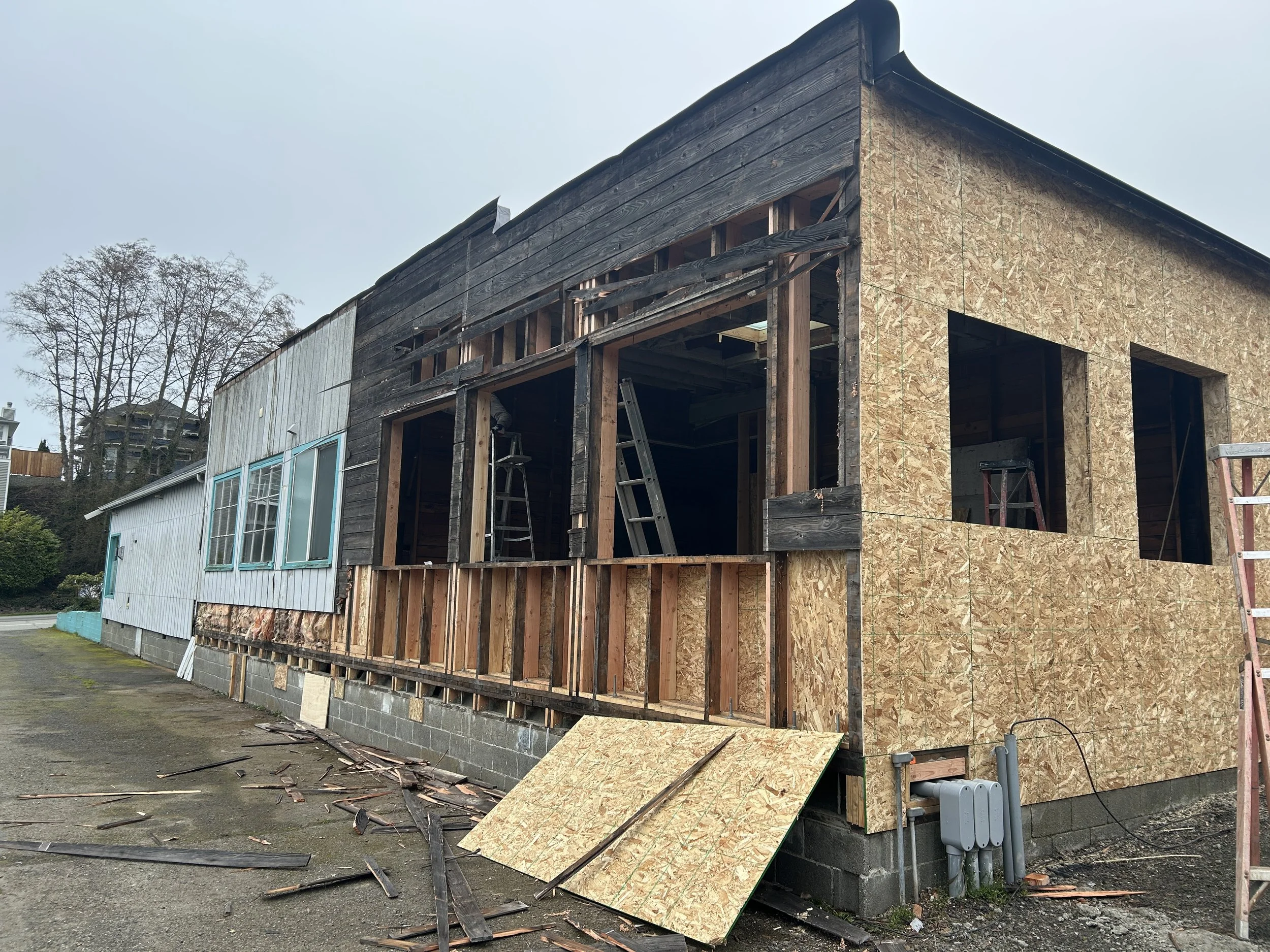

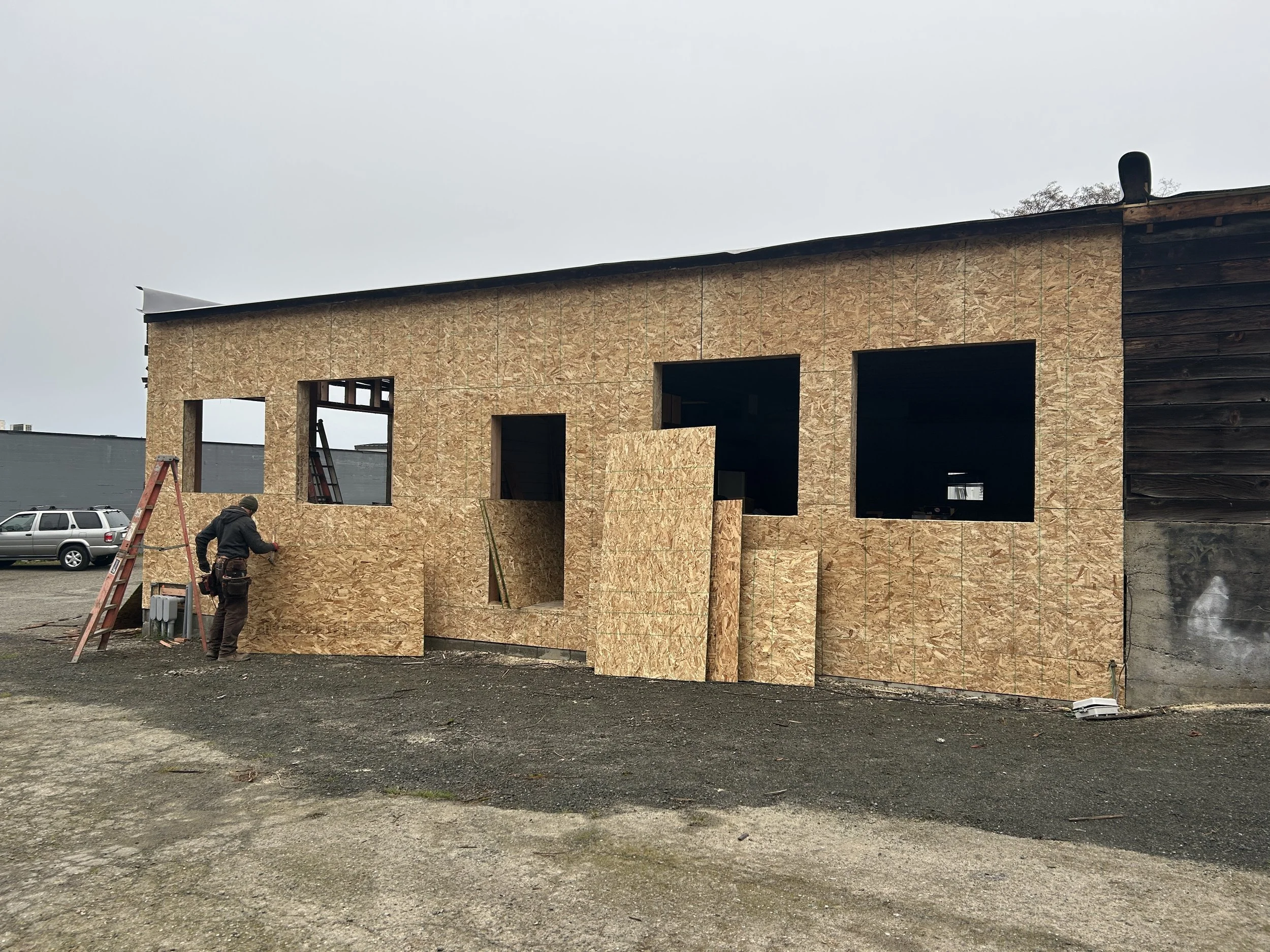

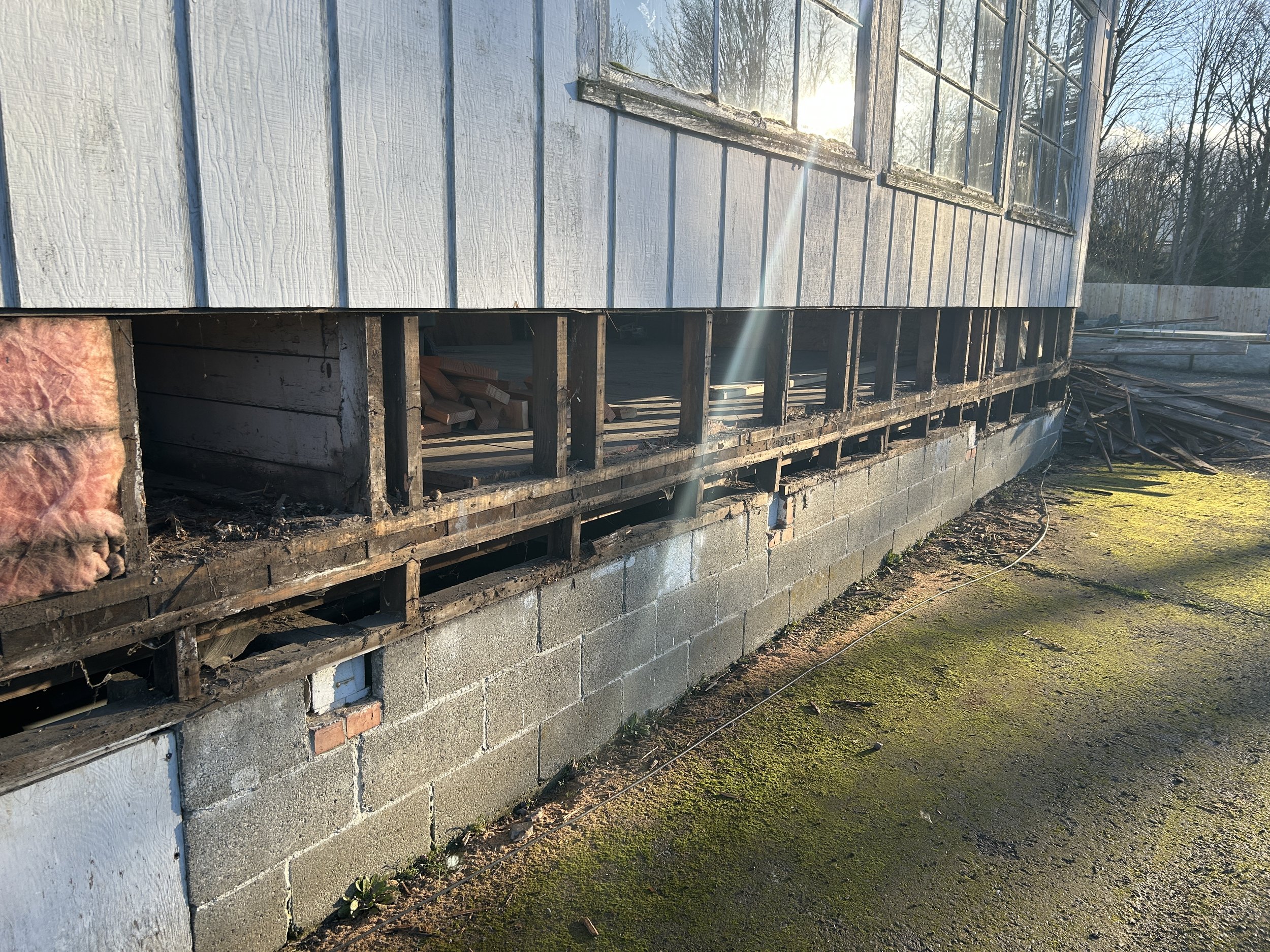

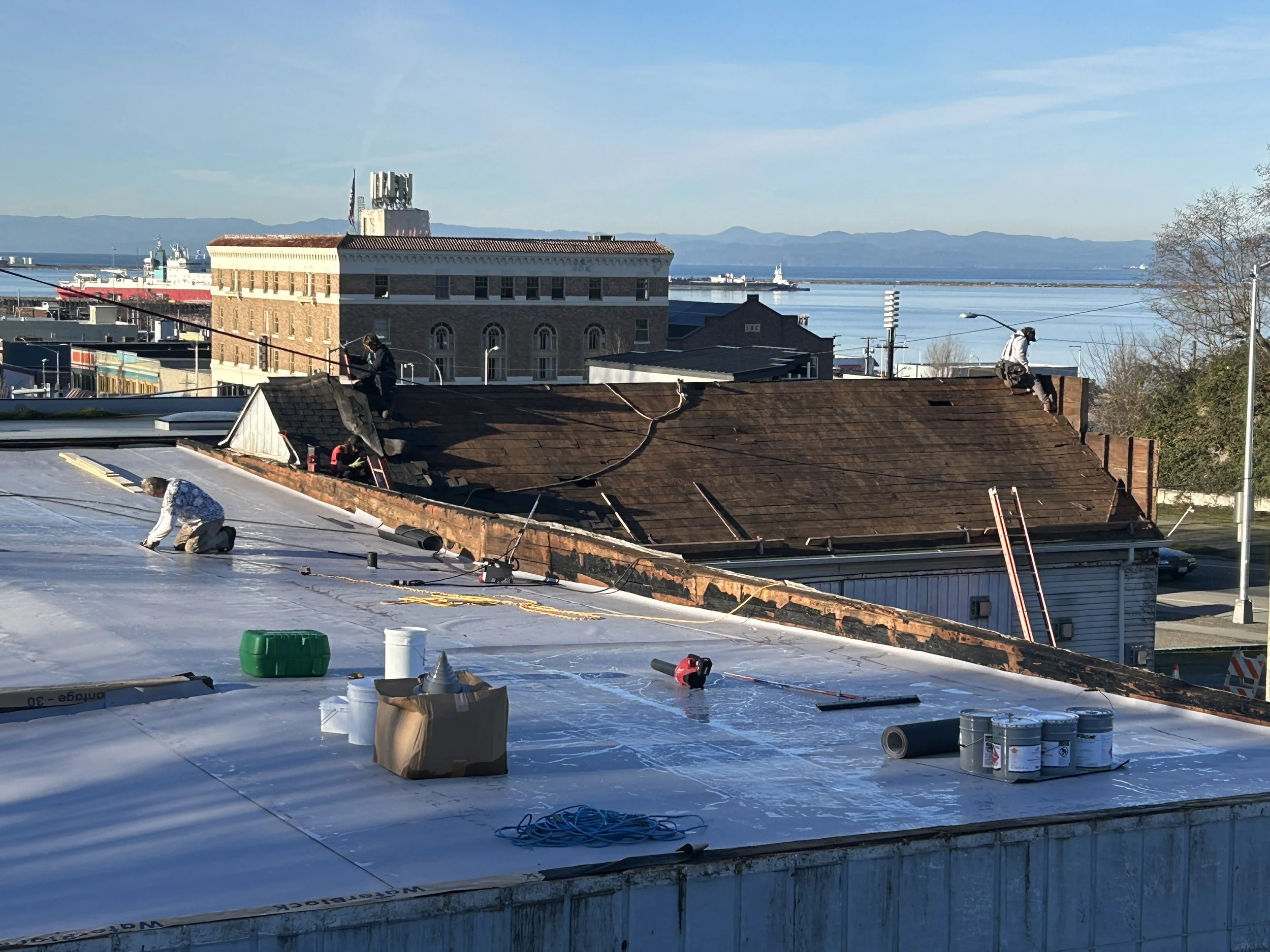

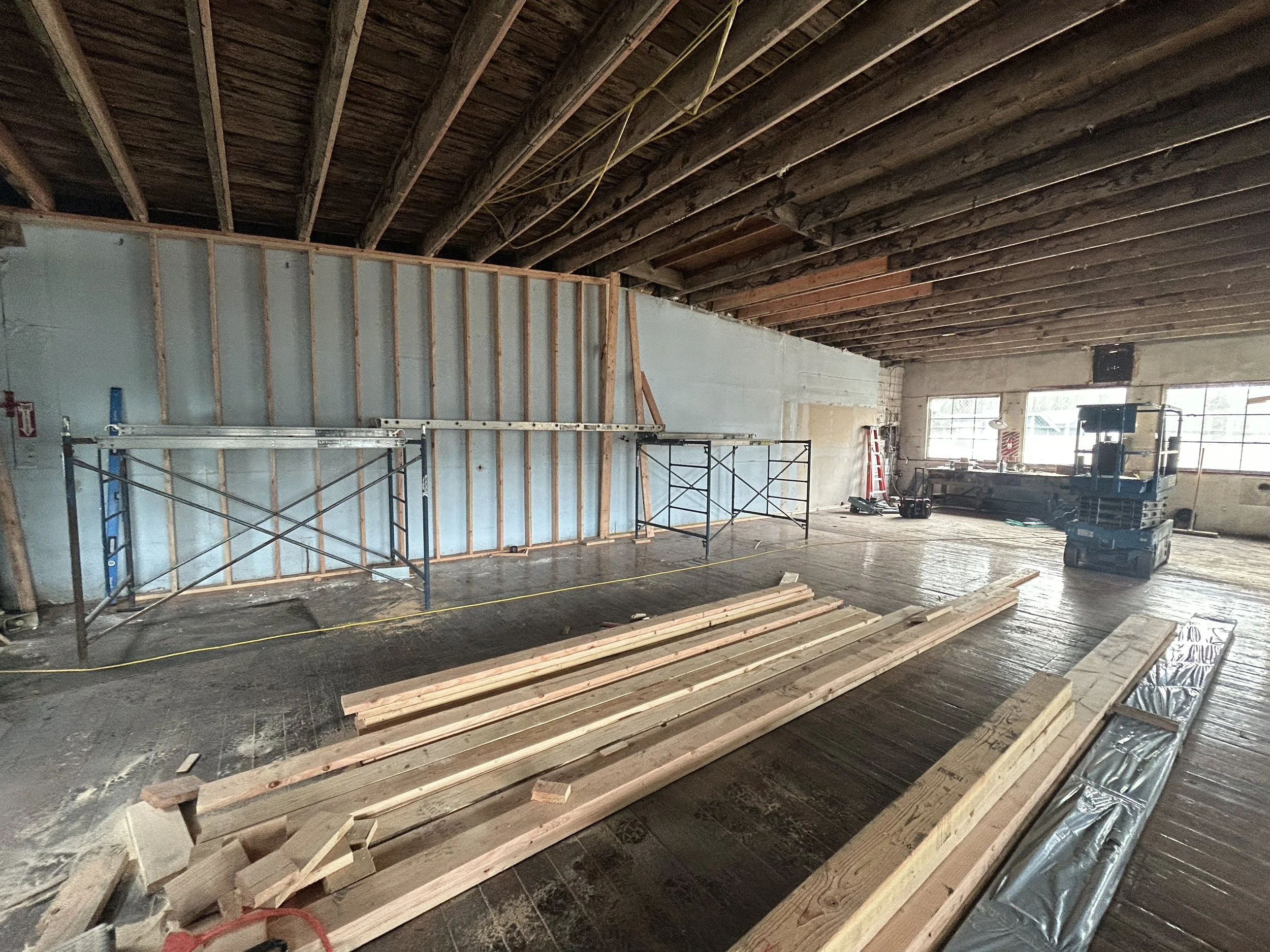

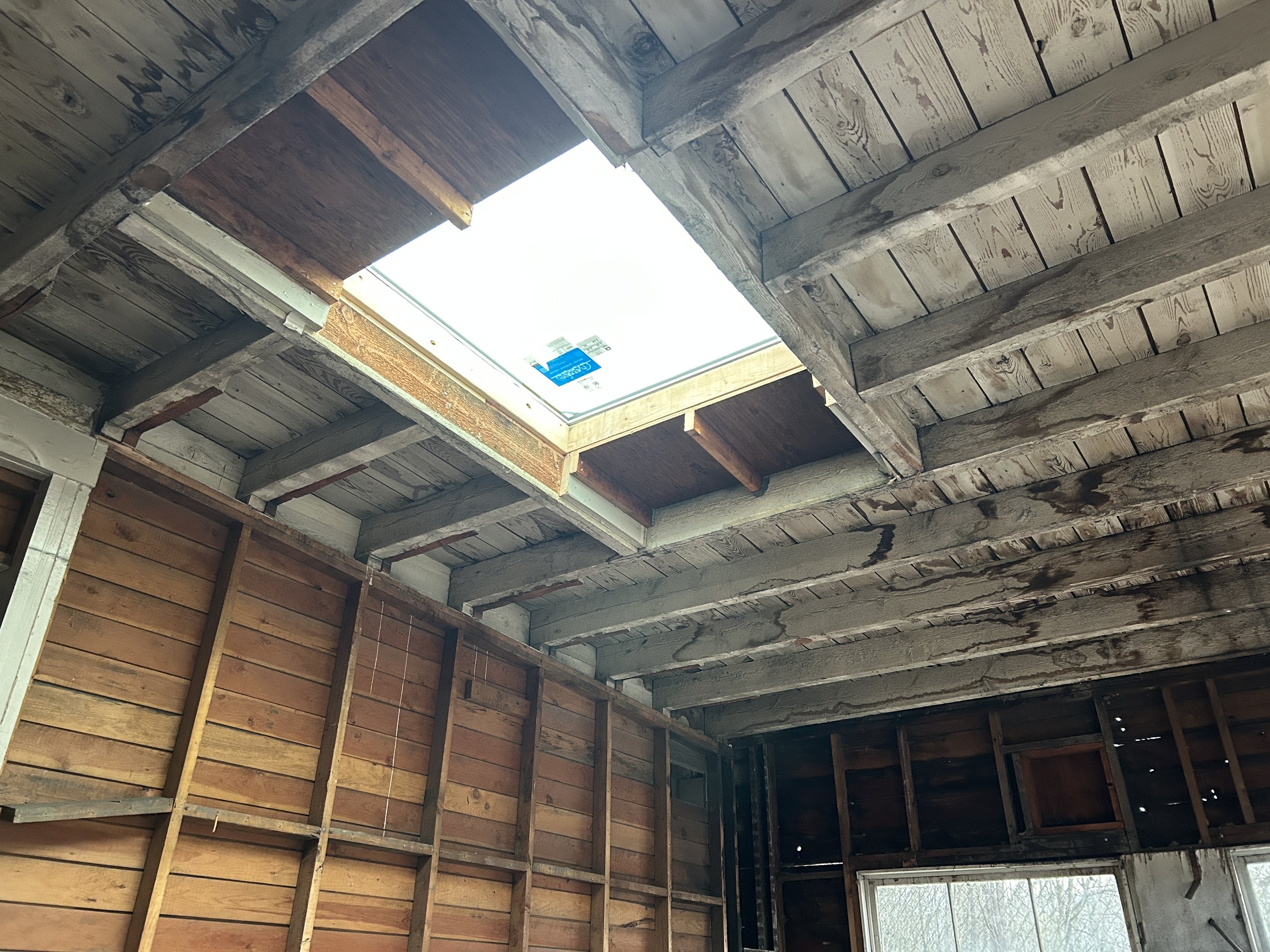

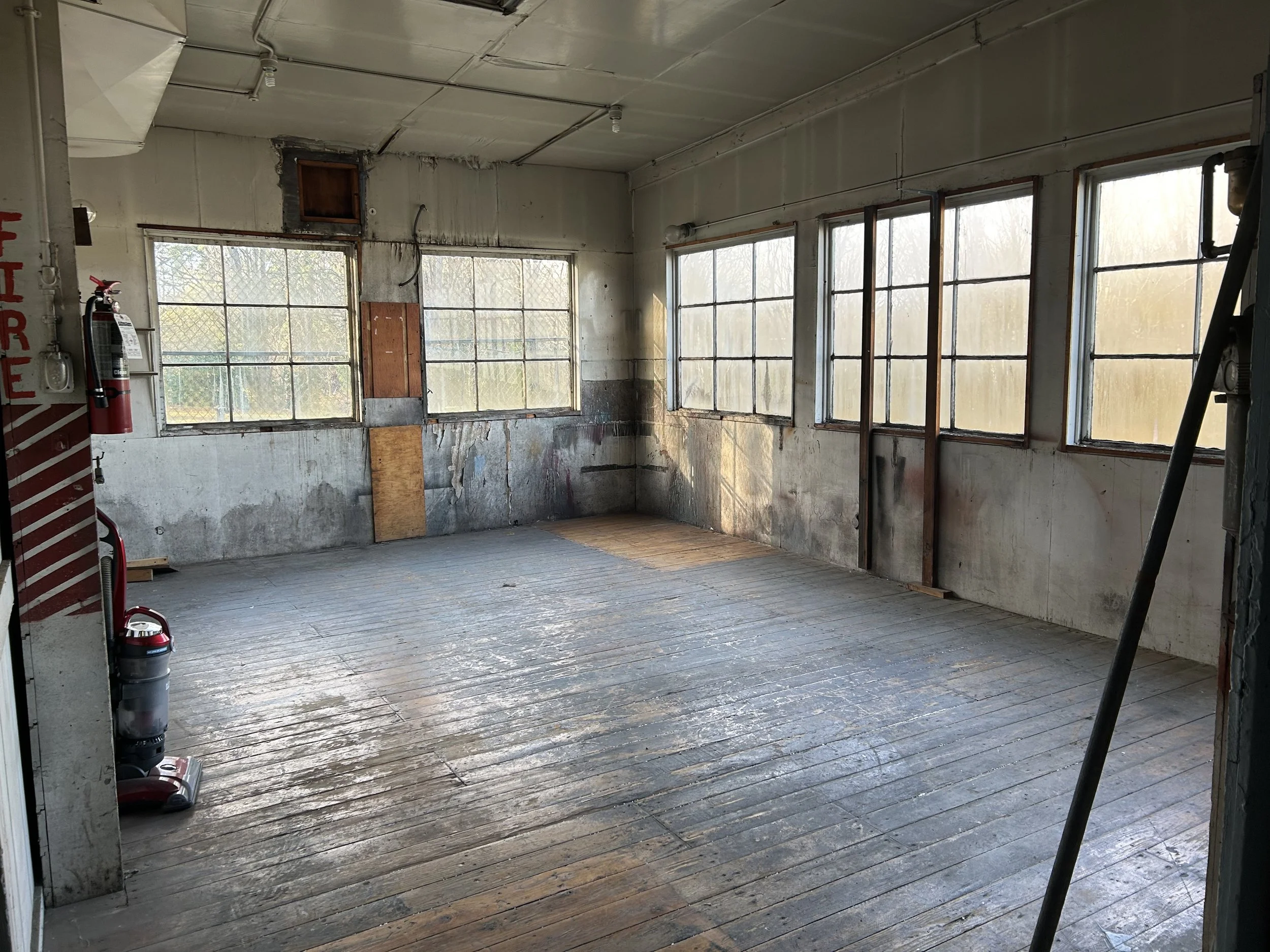

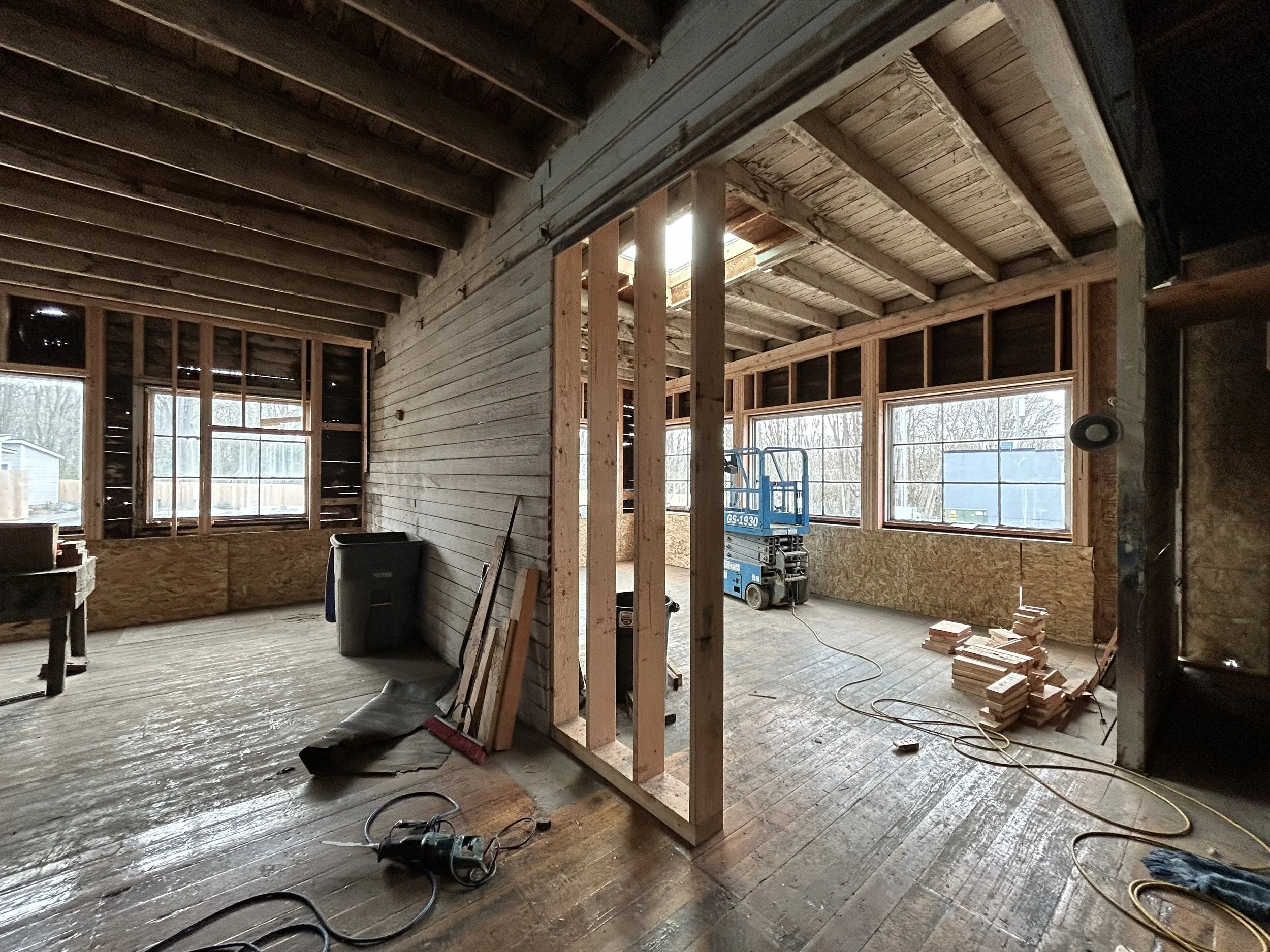

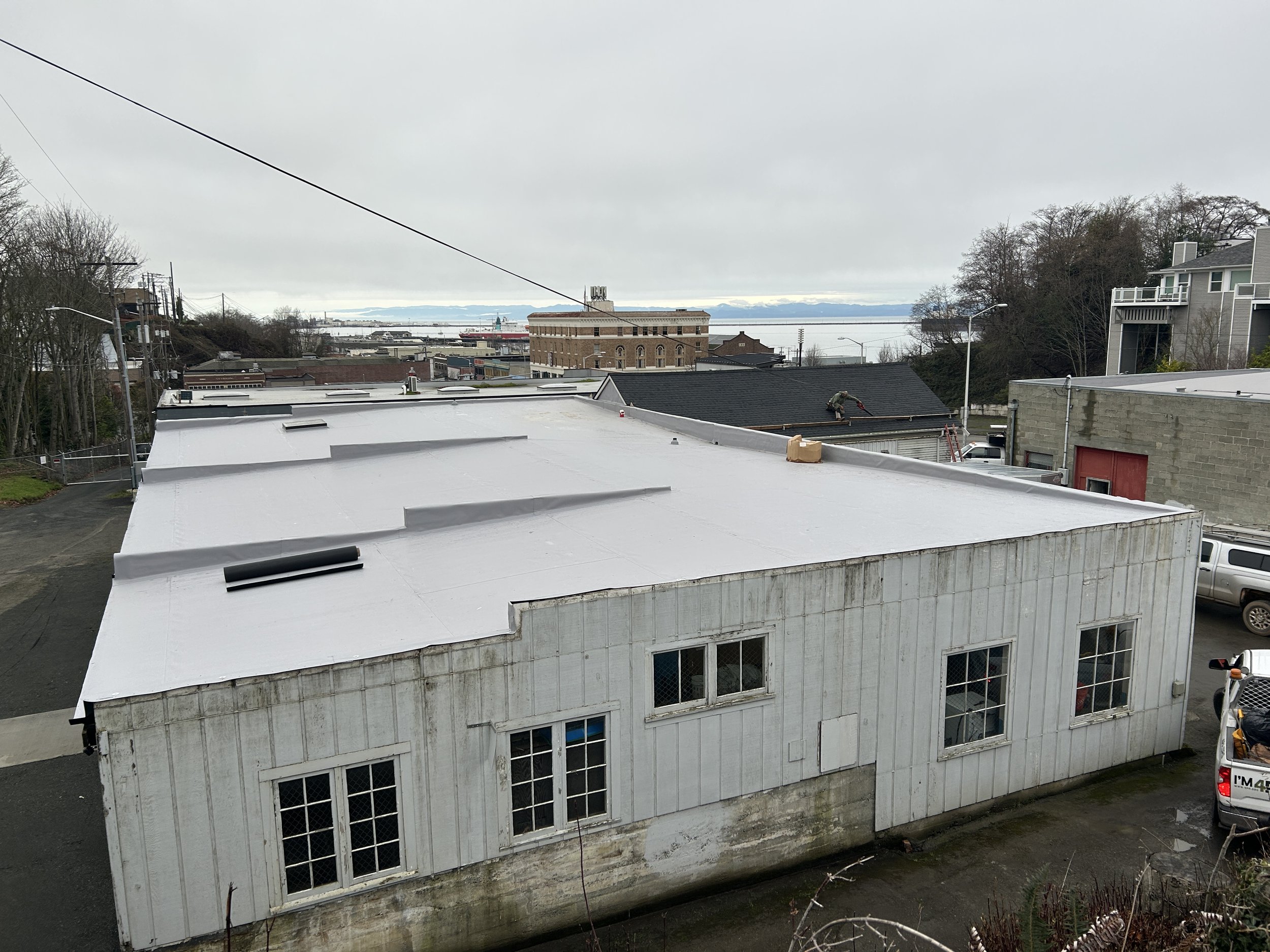

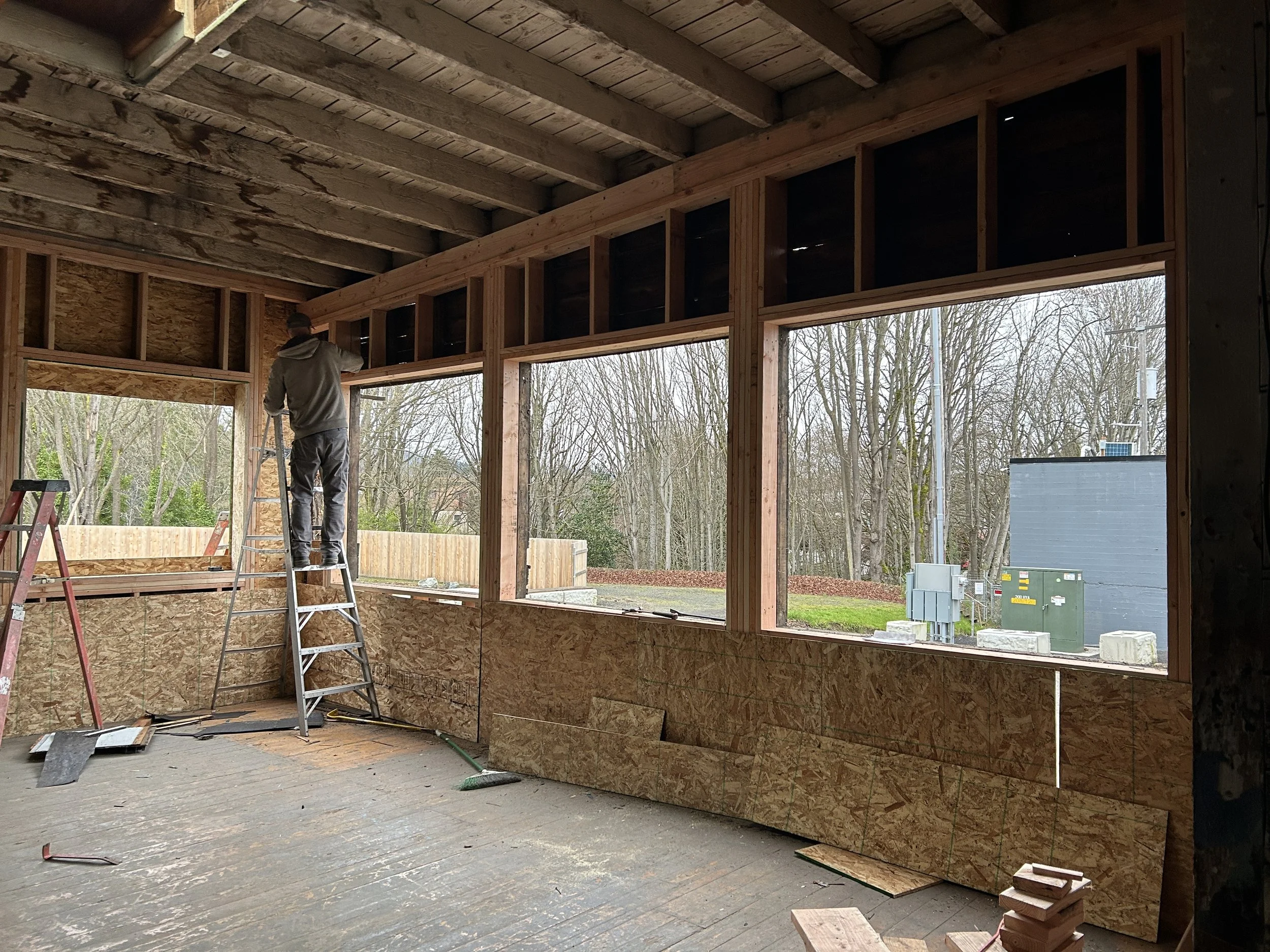

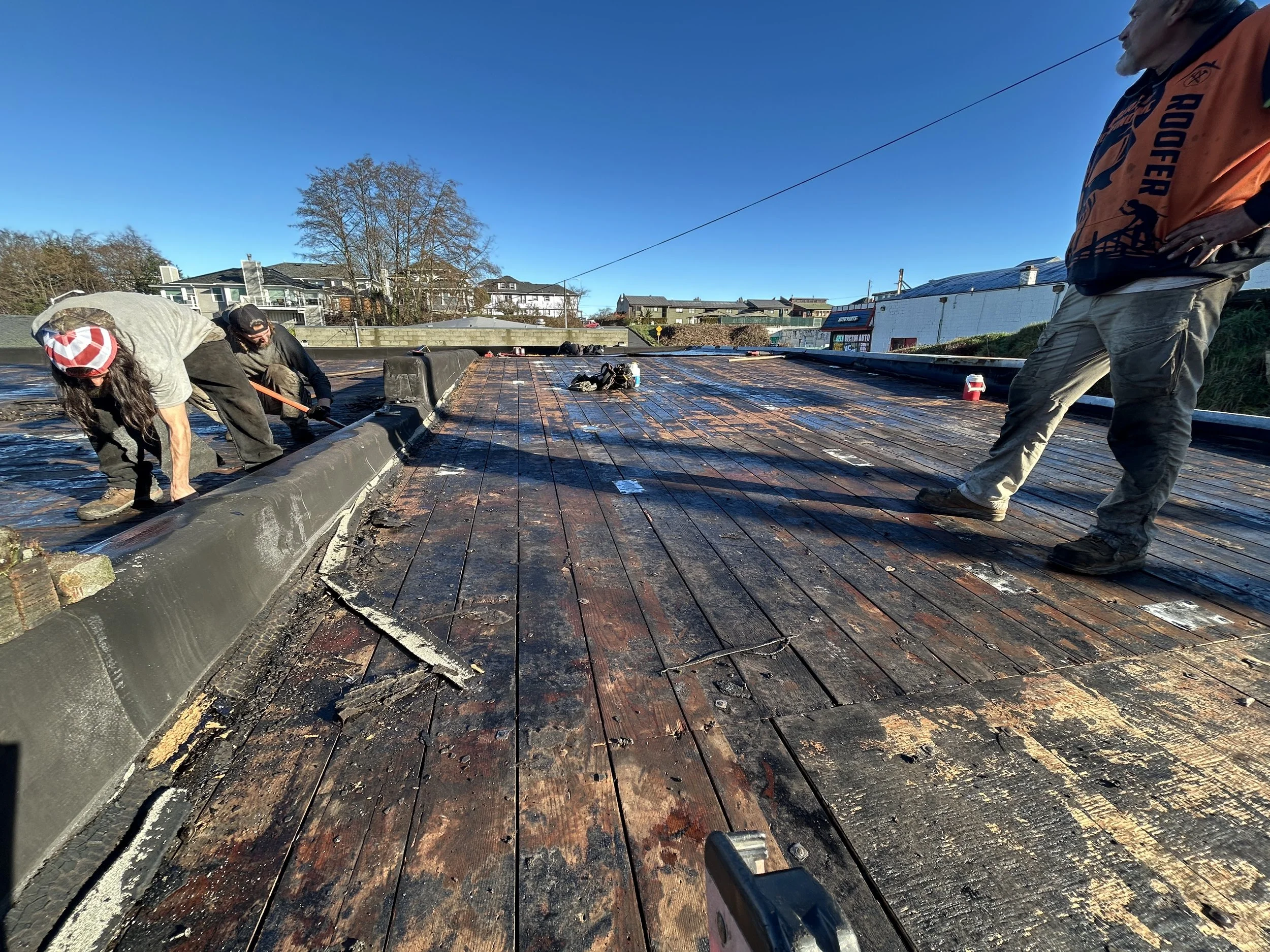

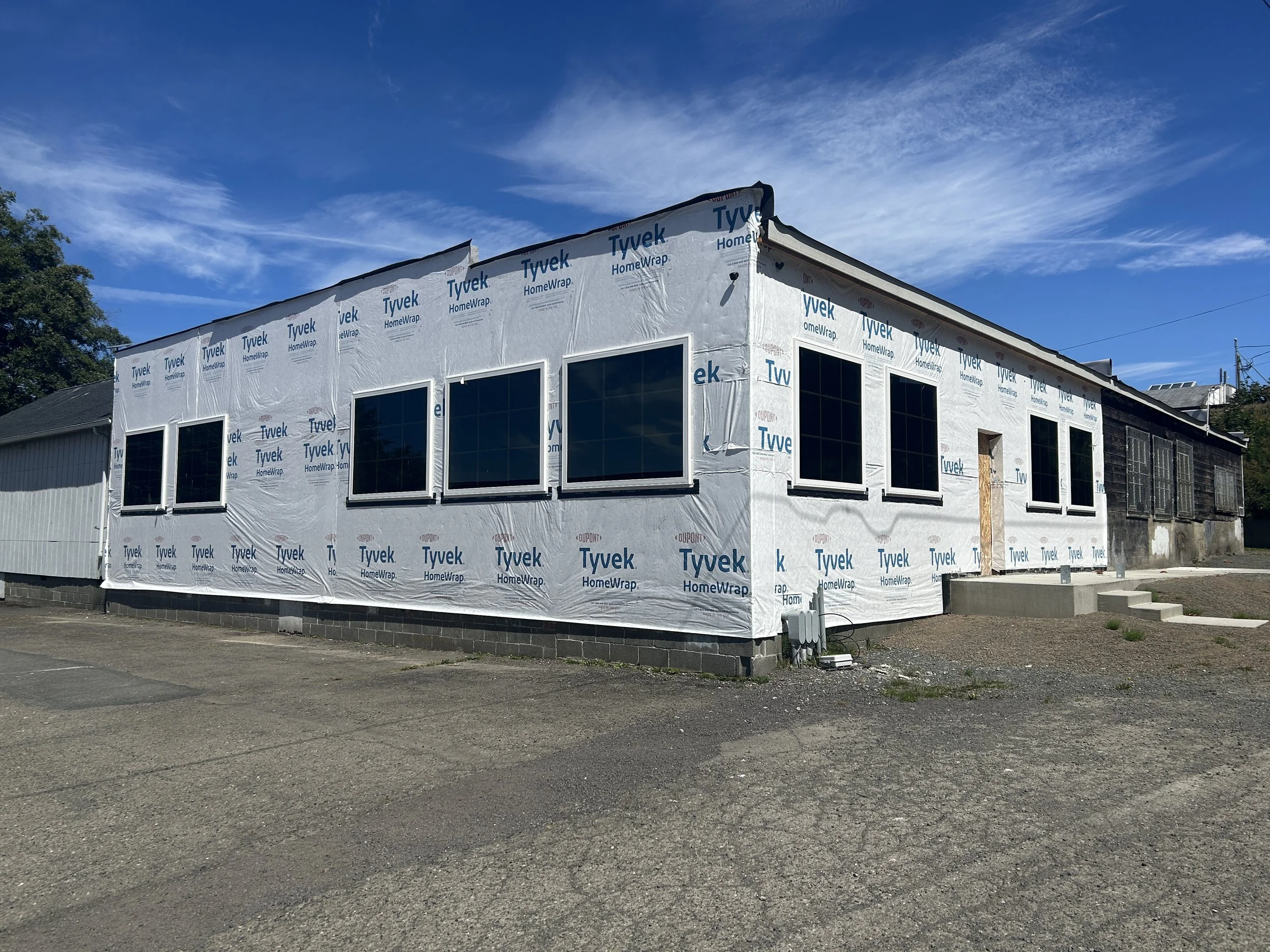

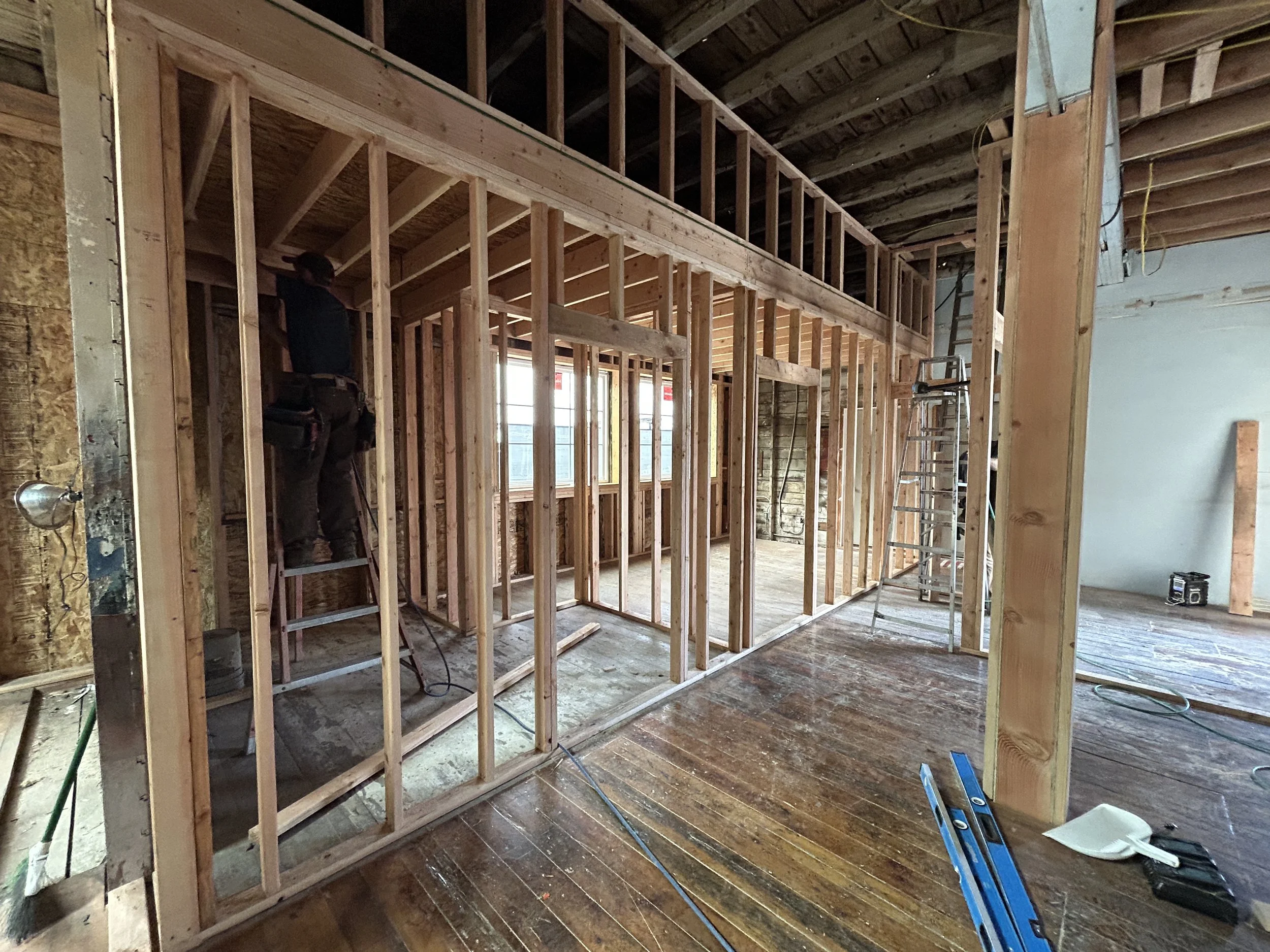

Permits for phase 3 have also been attained. This portion of the project will be the bulk of both time and expense involving complete renovation of buildings built in the 1940’s.

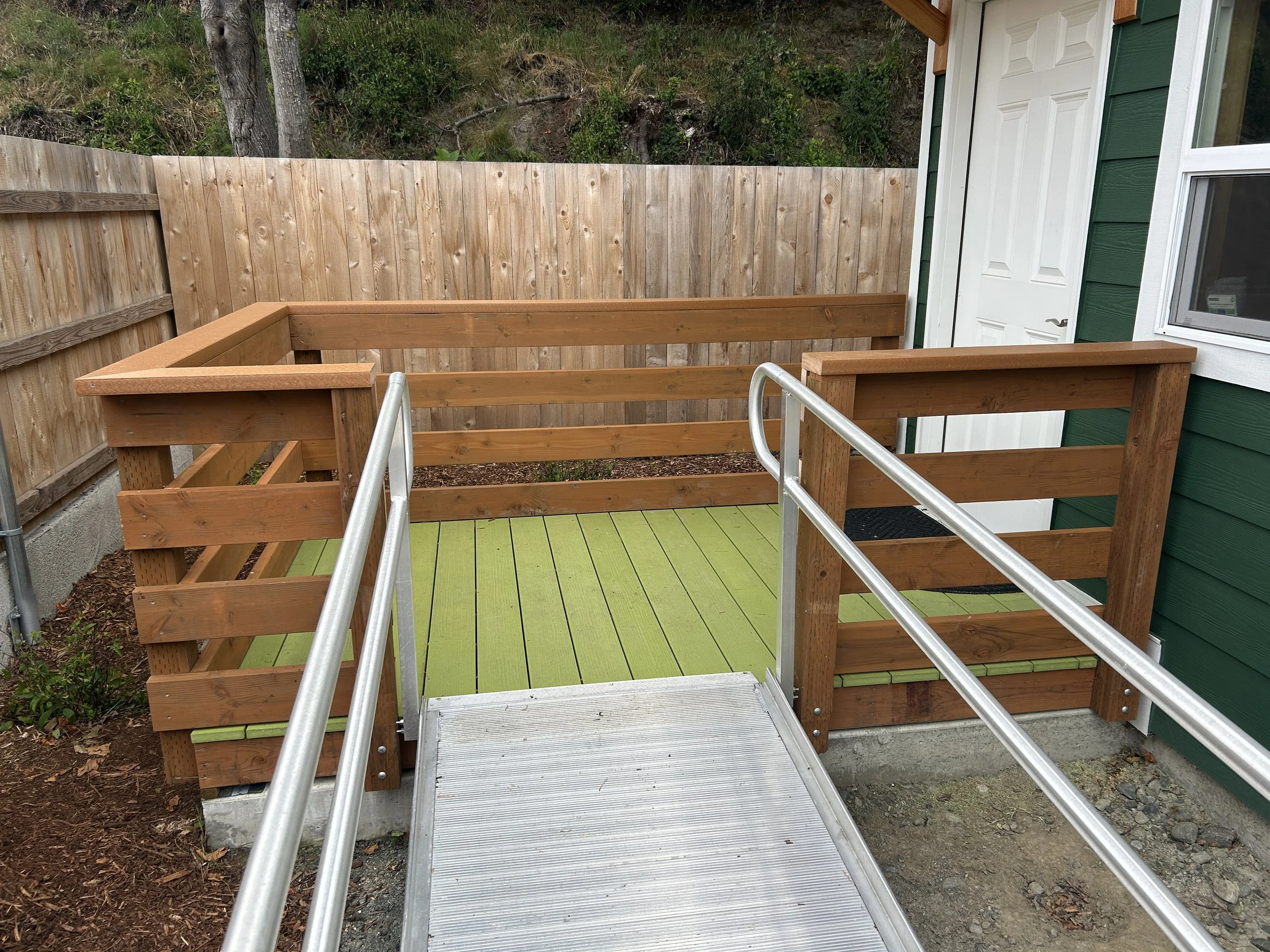

The common facilities that will be available 24/7 for residents will include individual restrooms with showers, kitchen and dining area, laundry, and a recreation space.

Phase 3 began in fall of 2025 and is currently underway.

Phase 4 :

  • Retail business development

Estimated completion date: TBD

Cost: TBD

The renovation of our retail space is not in the immediate plans (before 2026) but should be considered for the overall master plan of the campus.

We have a retail business model in the works to support Touchstone residents with employment and skills training.

The building we have on site for this endeavor will need renovation to reconfigure the internal layout, plumbing, electrical, and other modifications for a working retail/manufacturing shop.

Common Questions

Take a glimpse at where we started from

This video shows our property shortly after it was purchased in September 2023.

The major transformation you’ll see in the pictures below have been to the tiny home area that began in January 2025.

Each Tuesday on our social media outlets we post a TINY HOME TUESDAY update with the latest work being done, plus an invitation to donate directly to our campus development.
